Rostered Turns

       September

ELR Autumn Gala - around 217 miles throughout the event!

     18-20th

August 2026 Update

Nothing much to report on this month work wise although we are happy to report that we've completed 4 successful running days with 0 issues. We have an additional running day on the 6th September where you can grab yourself 64 miles and then we have some participation in the Autumn Gala, after that we are pulling the locomotive out of service to make a start on the bodywork and paint job.

July 2026 Update

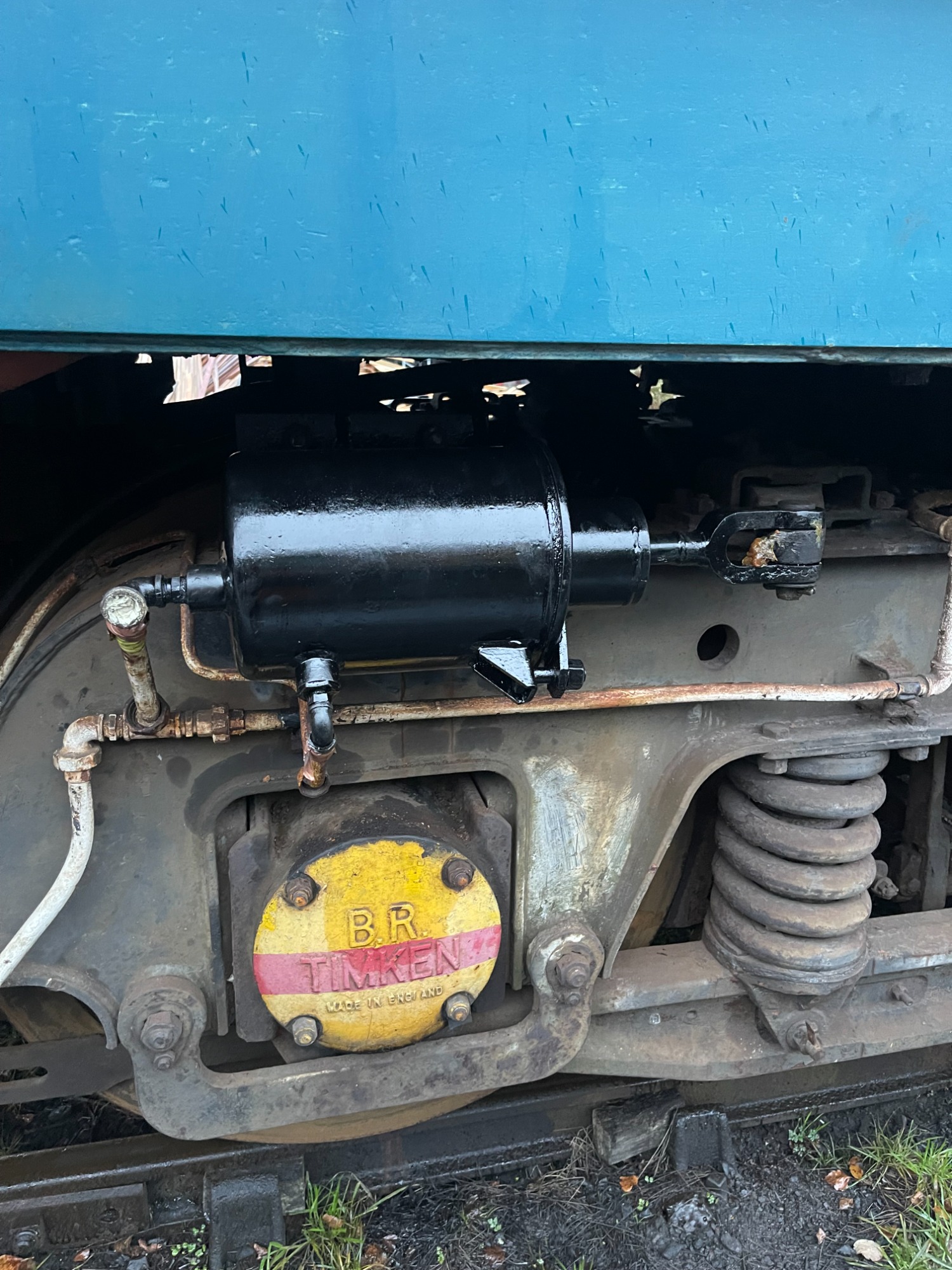

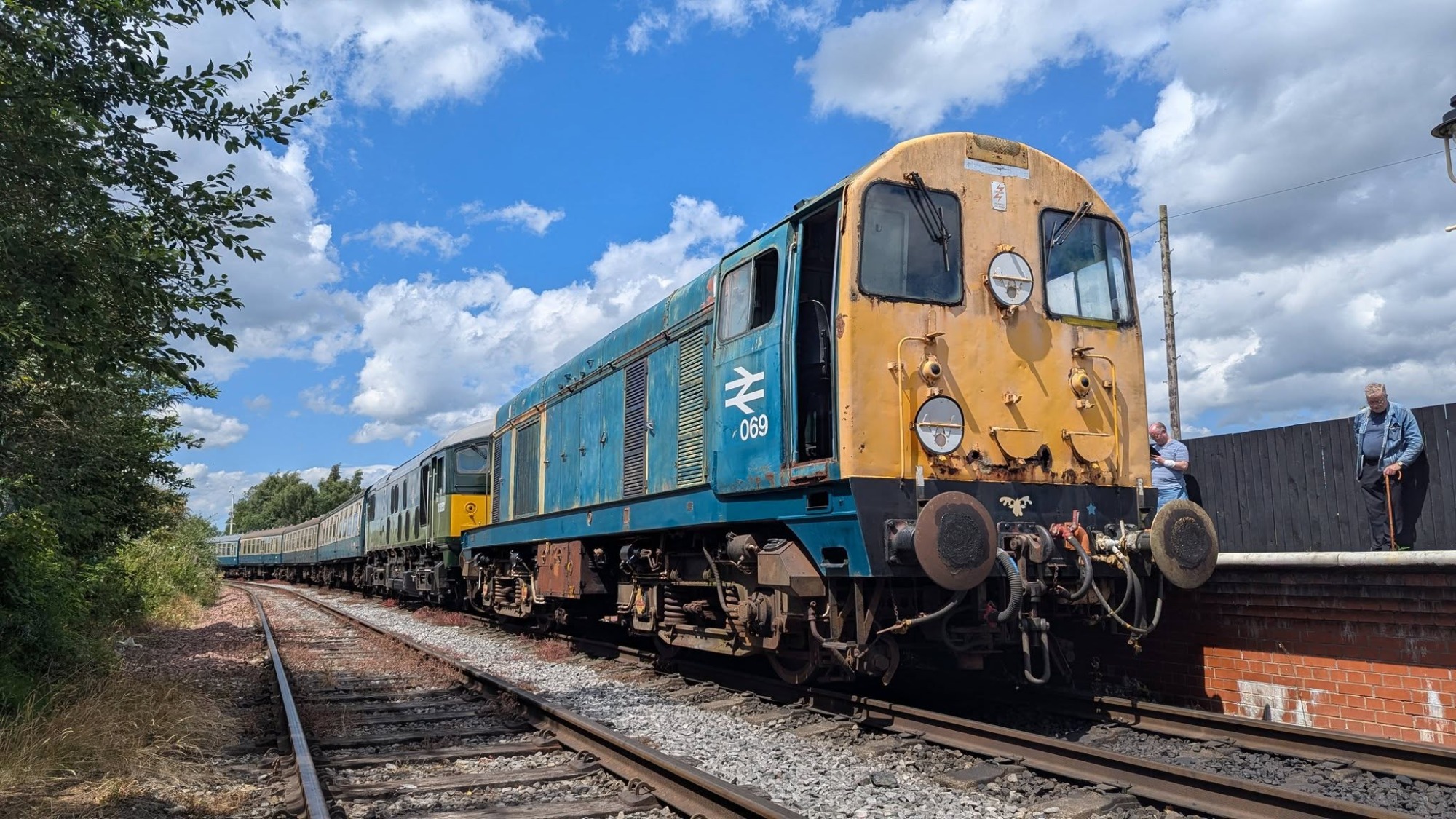

We had our first gala appearance for the ELR!

The group would like to say a huge thank you to everyone who travelled out to support 069’s first proper venture in roughly 13 years. We hope it brought plenty of smiles and filled your lungs with goodness. YouTube and Facebook have already started filling up with footage.

I’ve been told the sales stand did fantastic and sold lots of 069 merchandise, all of which goes straight back into the money pot.

We didn’t offer a lot of mileage, but we did manage to get out onto the railway for three days and complete a smidge over 40 trouble-free miles (once we got out of Baron Street). We did fail on shed before the Beerex, but thankfully two of the gala team members were still around Baron Street, so we were able to find some material to temporarily fix the issue and join the party back at Bury.

Although we successfully assisted 20303 on Thursday and managed a blast up to Ramsbottom on Friday solo, the real test was attempting to pull roughly 420 tonnes up the Broadfield section. We knew full well that a little eight-cylinder, 1,000hp machine wasn’t capable of doing it alone and would need assistance at some point, so we asked the Class 58 driver to hold back until he noticed the speed rapidly dropping before giving us a shove. More importantly it was more about testing the machine’s capabilities to see whether all the hard work, blood, sweat and tears had finally paid off. If anything was going to happen, it would have happened at that point. I think it’s safe to say we now have a machine that’s ready to run.

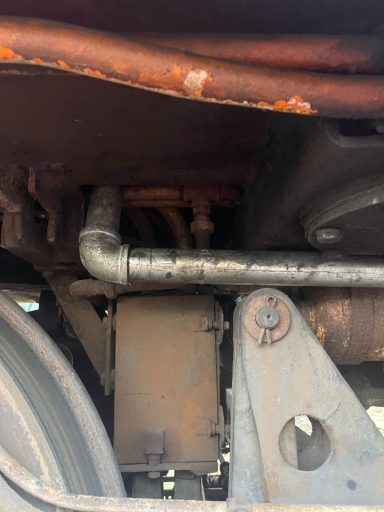

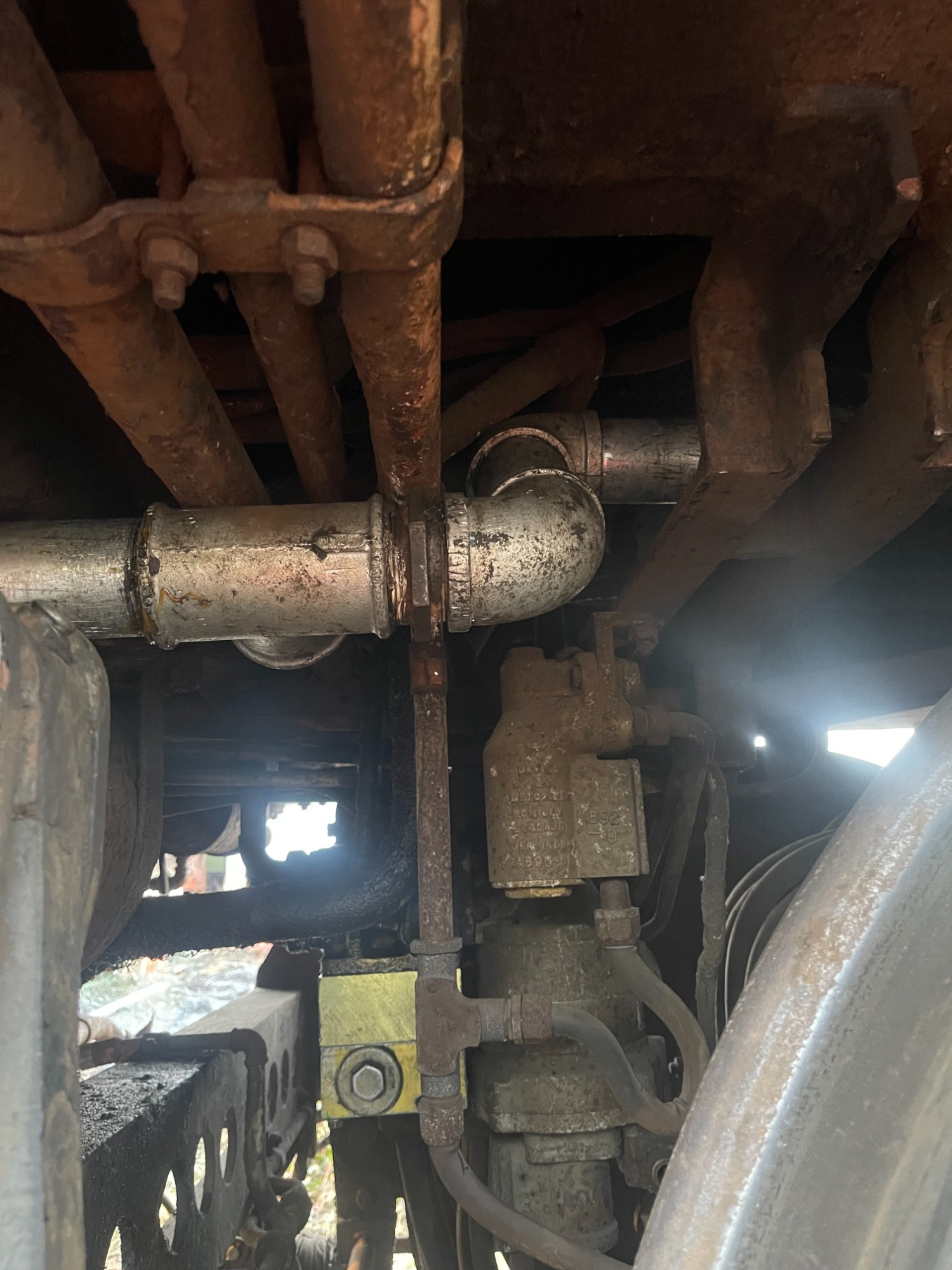

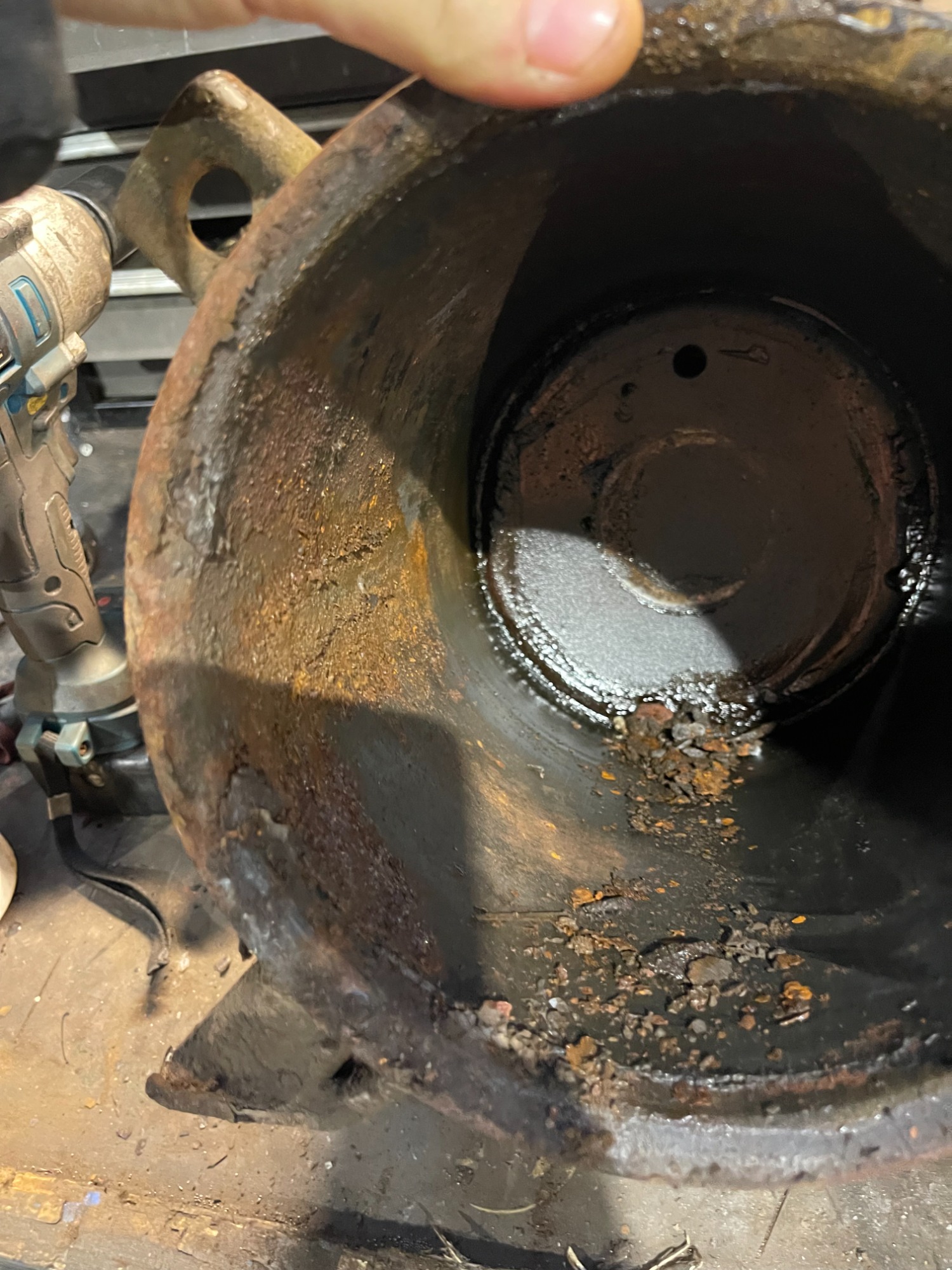

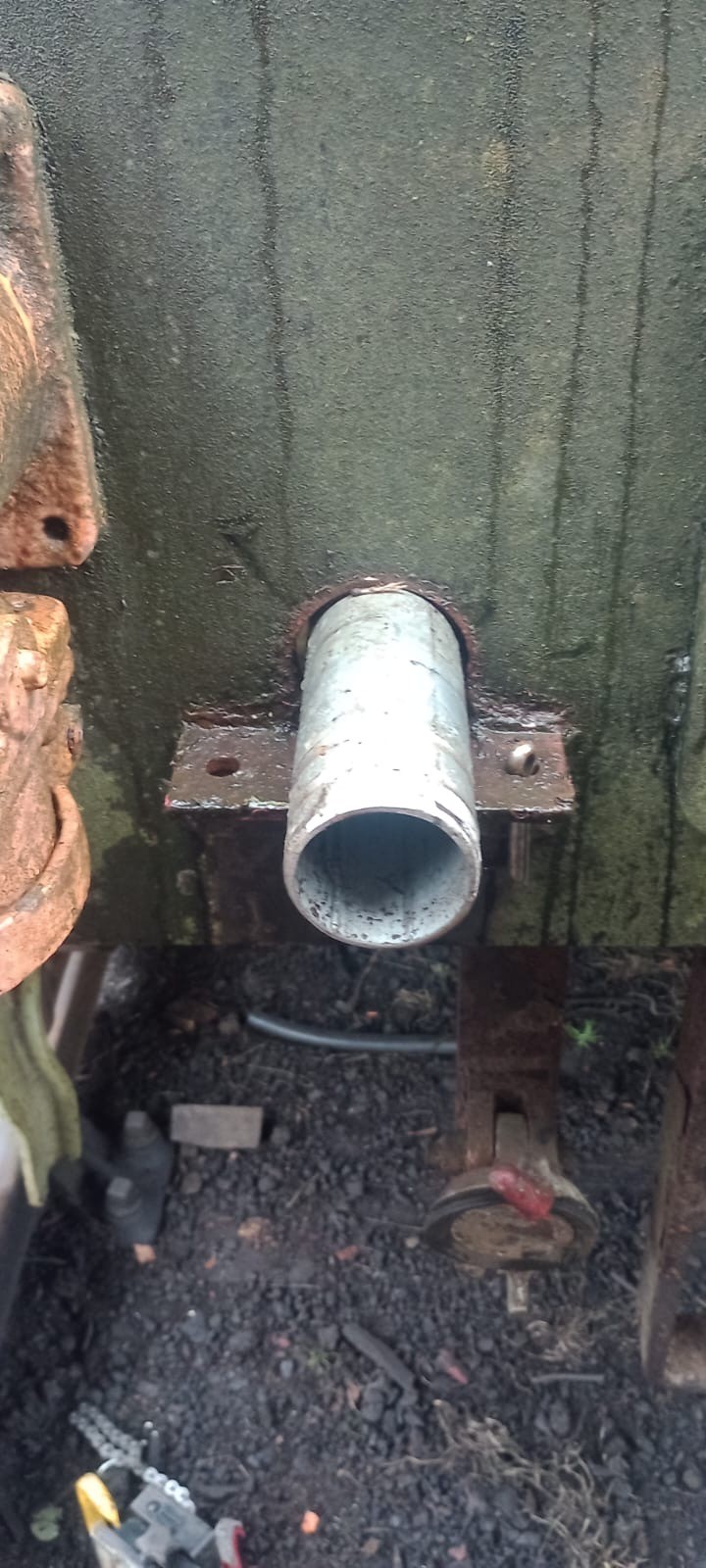

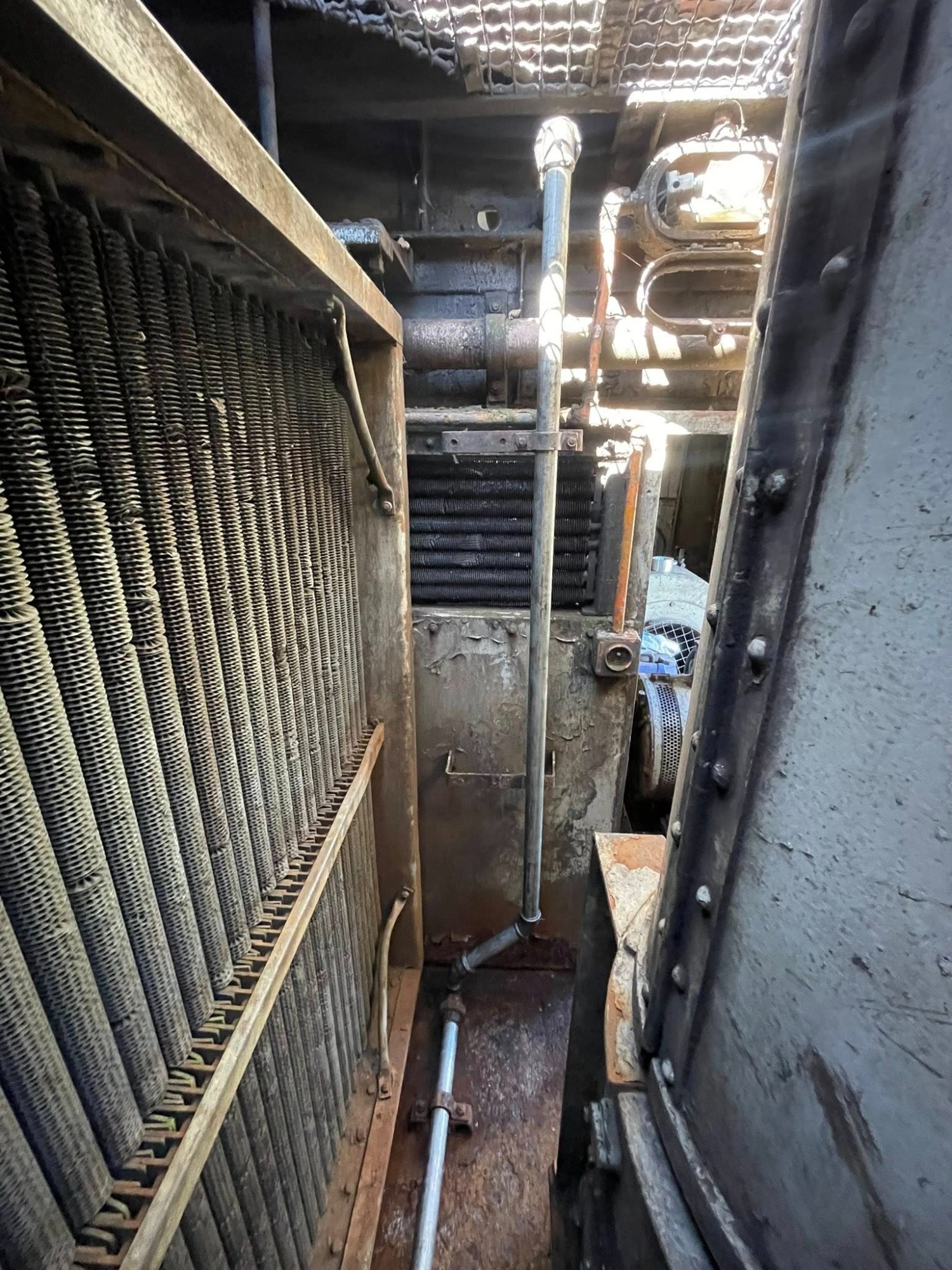

That said, we do have a few issues that need attending to straight away. We’ve identified a small air leak in the engine room that leads into the floor. The section of pipe will need replacing before the loco goes out again, as it places an unnecessary load on the compressor, which has to work harder than it should to maintain pressure.

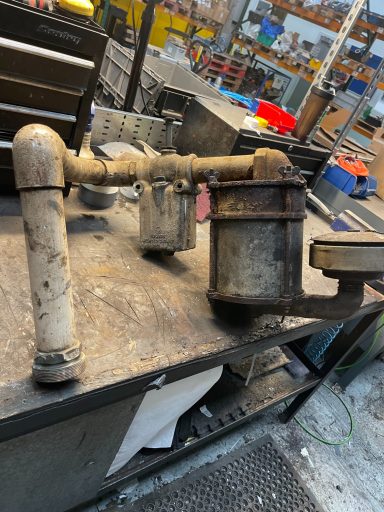

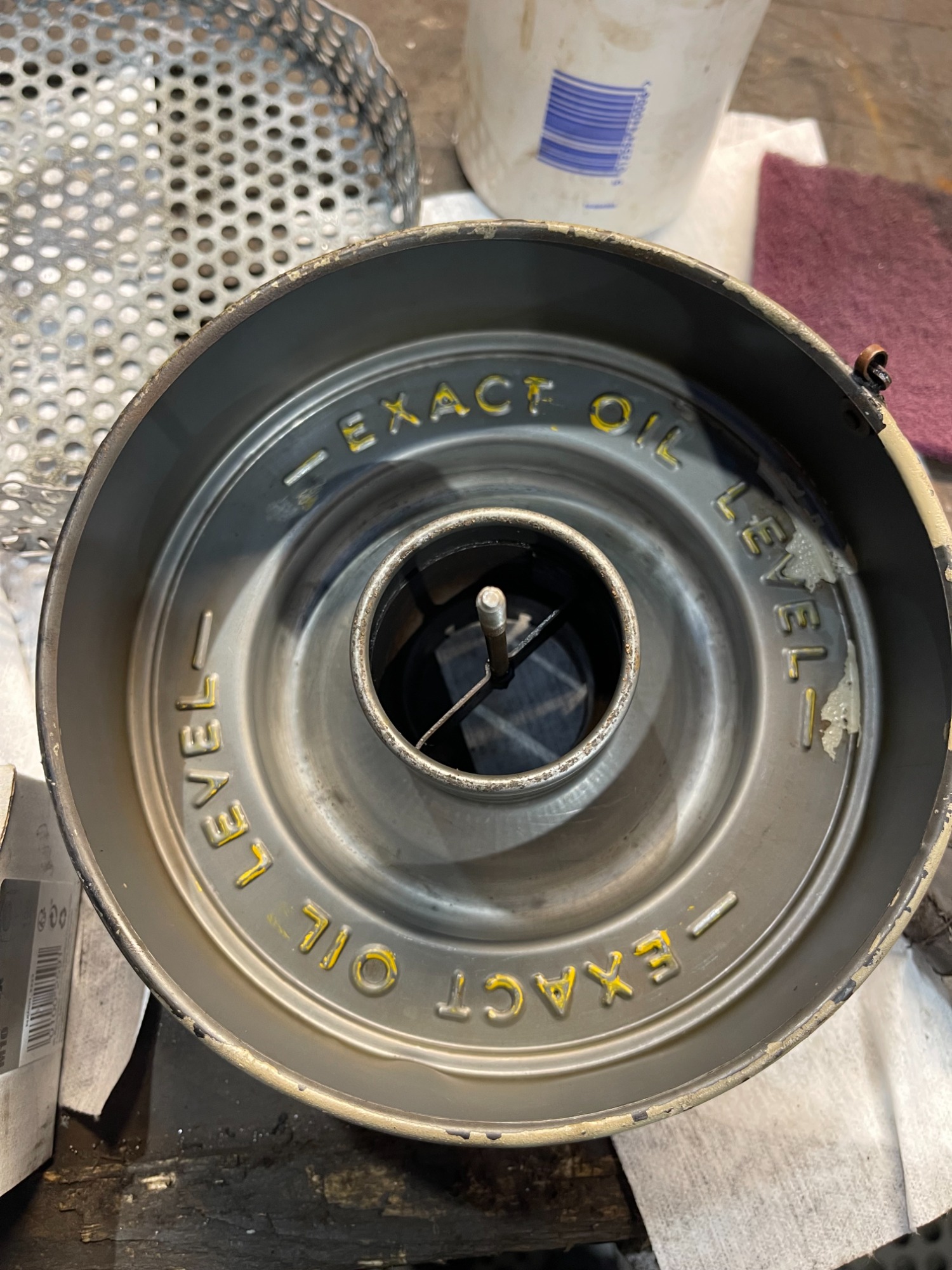

We also plan on working our way through the whole air system, starting with the strainers. We need to identify whether the strainers still have their filters fitted, as these should catch the debris in the system. At the moment, we seem to be finding small deposits in places they shouldn’t be reaching. Thankfully, most of the equipment underneath is easily accessible and fairly straightforward to strip and clean, but it shouldn’t need doing twice within two months, so some further investigation is required.

19th July

Work continues on the loco, we're slowly working our way through the air system ensuring no leaks or pipe work issues are present. With only the 1 working compressor, the less stress and extra work the compressor has to work the better.

Currently the priority is focusing on the other loco as we're 3/4 of the way through a power unit overhaul but a working day was planned to give the 20 some attention.

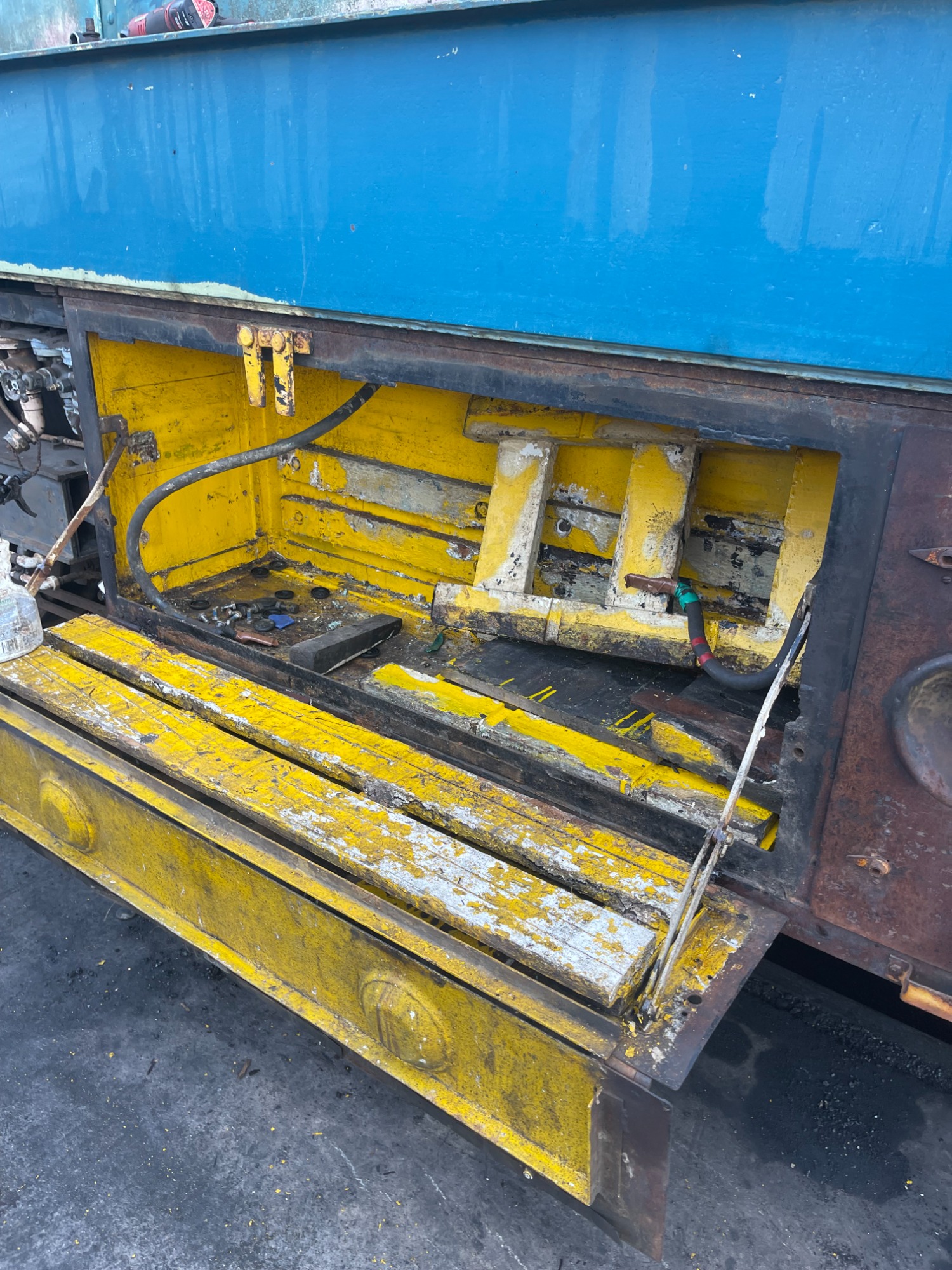

The plan of action was to go through the strainers that are located underneath the loco connected to various different sized pipes, these are designed to catch any debris that runs through the pipeline to save them getting caught up in vital equipment. We’ve reported previously that we’ve had debris travelling into places where they shouldn’t be and we’ve had to strip them down to clean them for the loco to work as intended. Elliot worked his way through the system removing 2 strainers so far, stripped down, a thorough clean and refitted within a few hours.

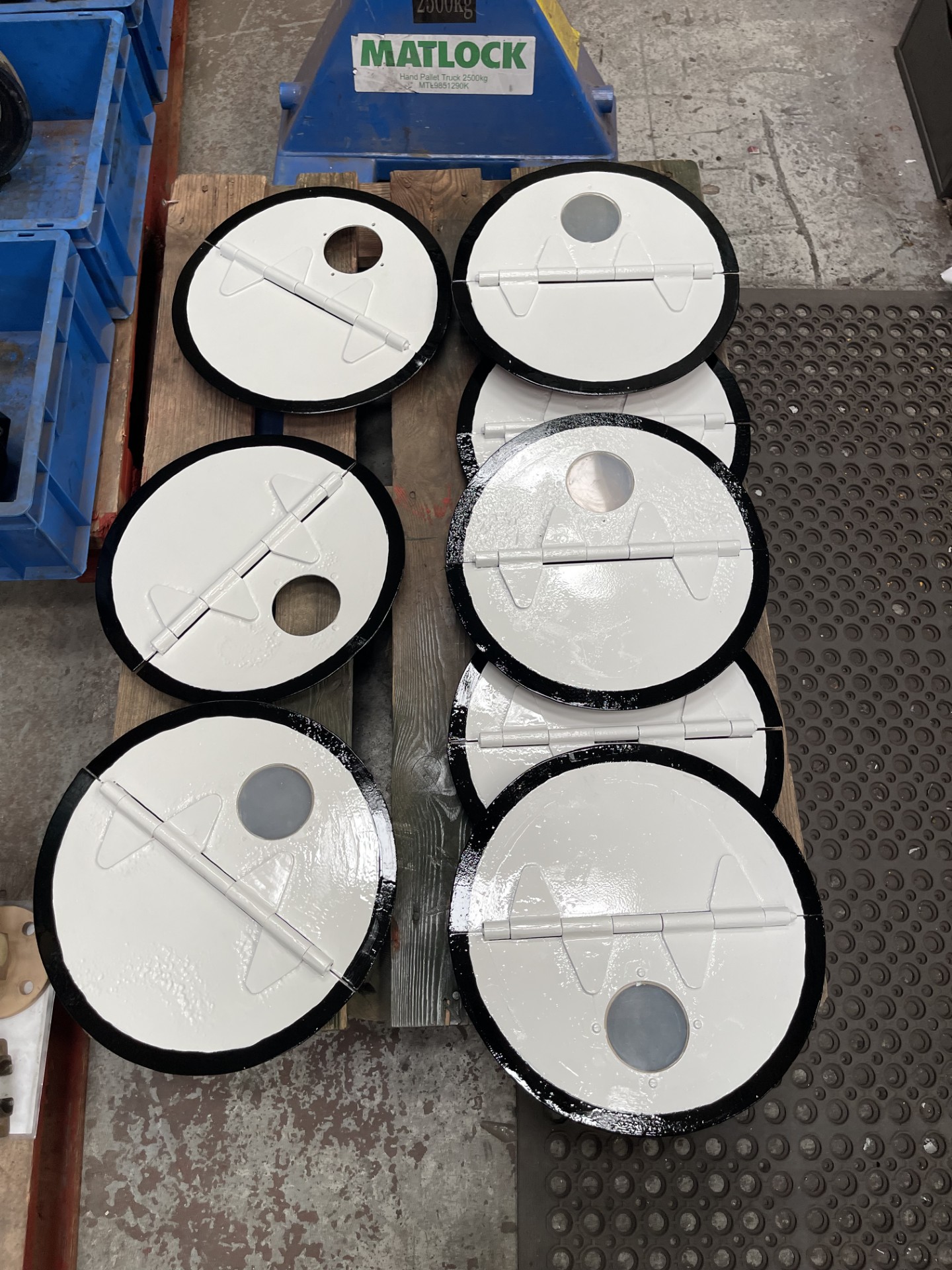

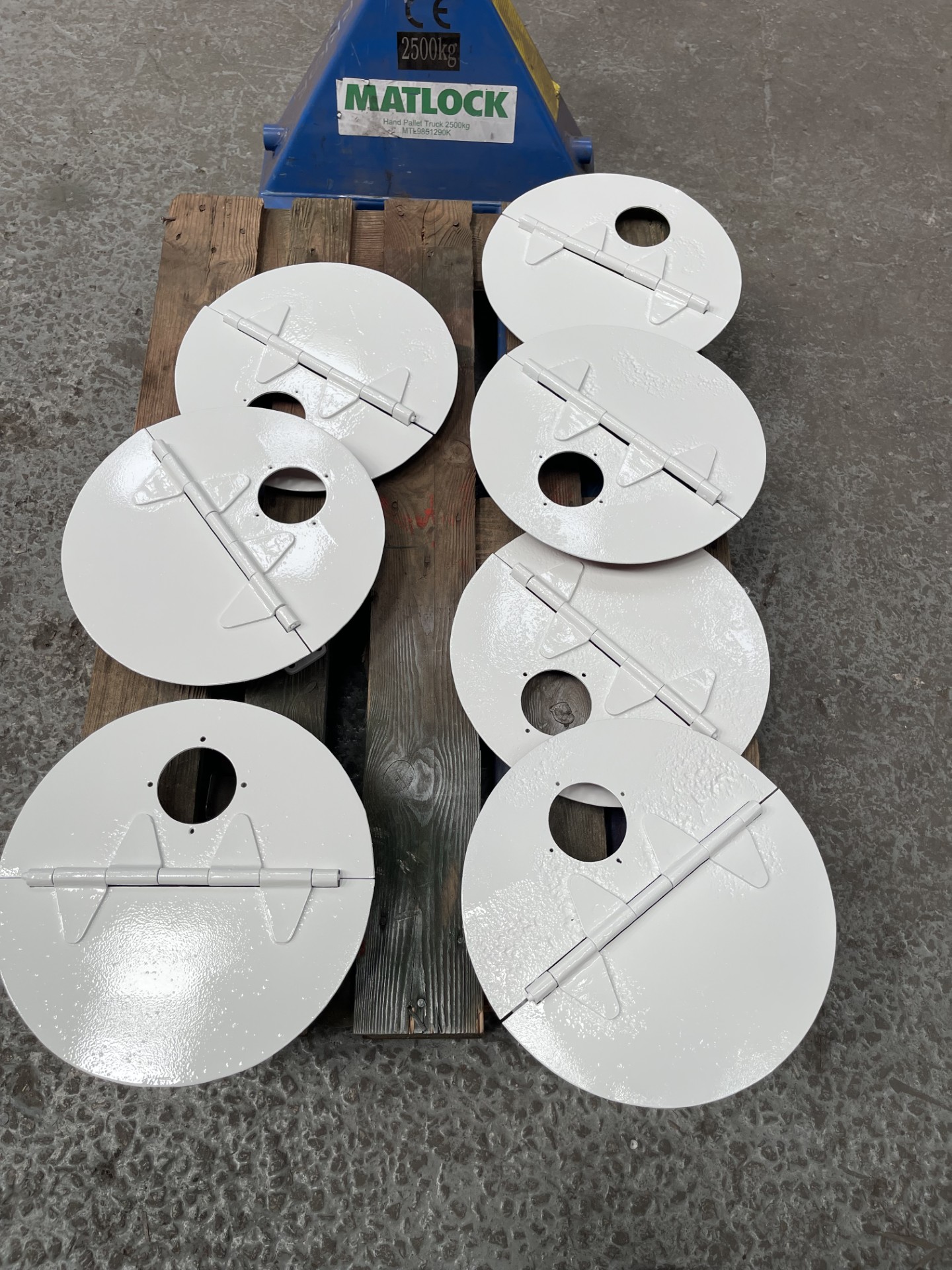

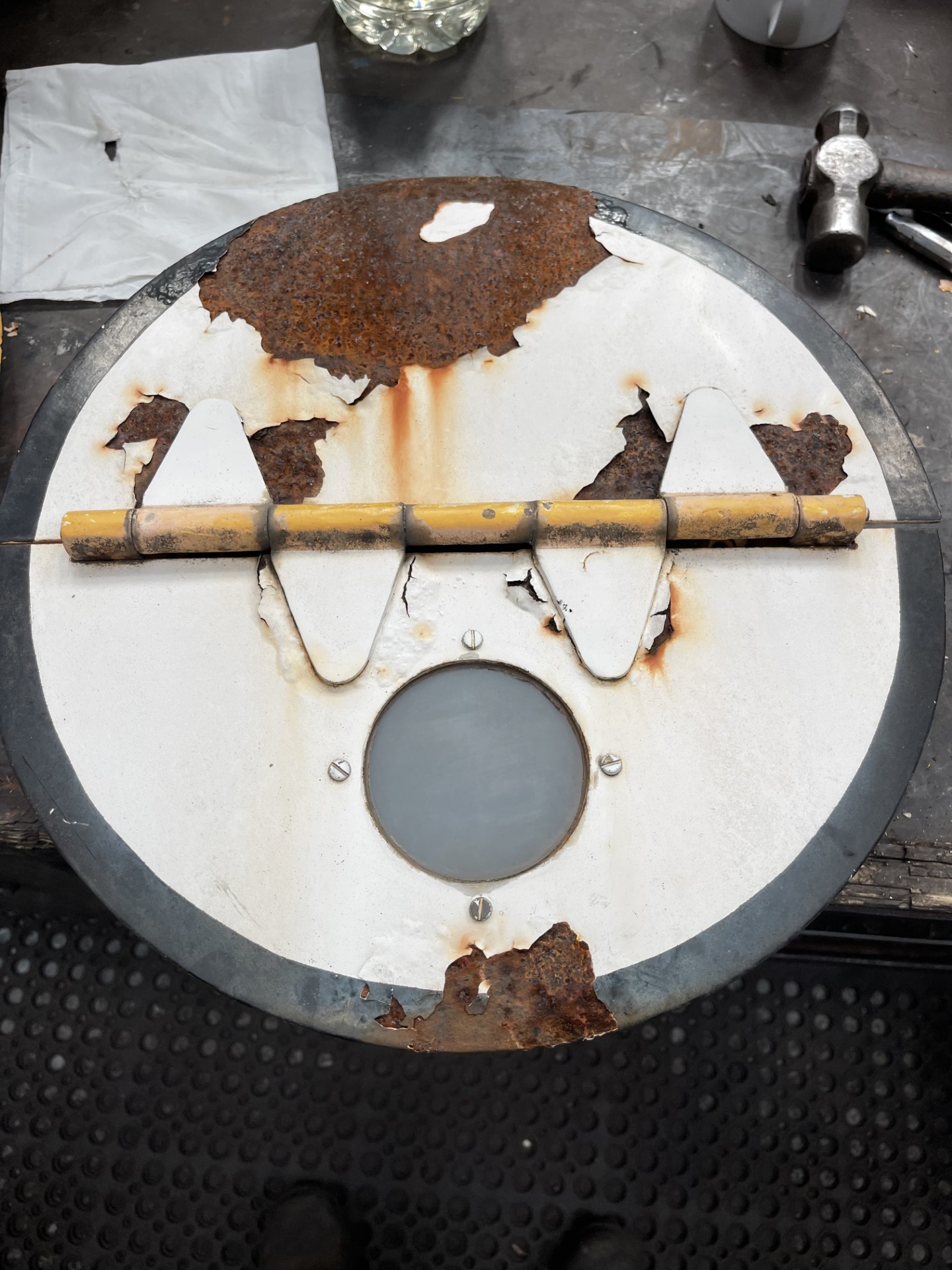

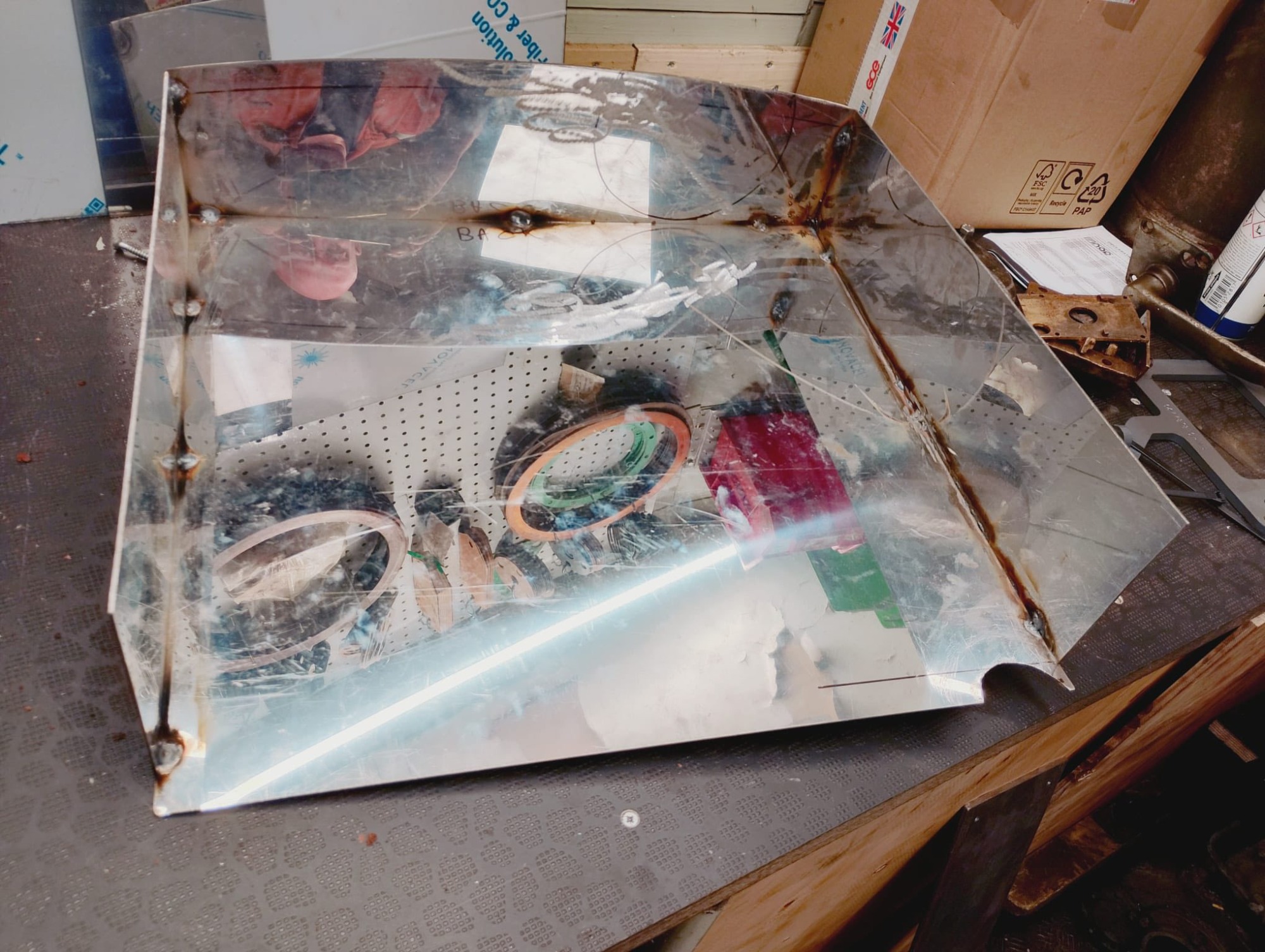

Ben focused on treating the external surface rust around the loco before removing the discs from both ends of the loco, these will be getting bead blasted and primered ready for painting yellow.

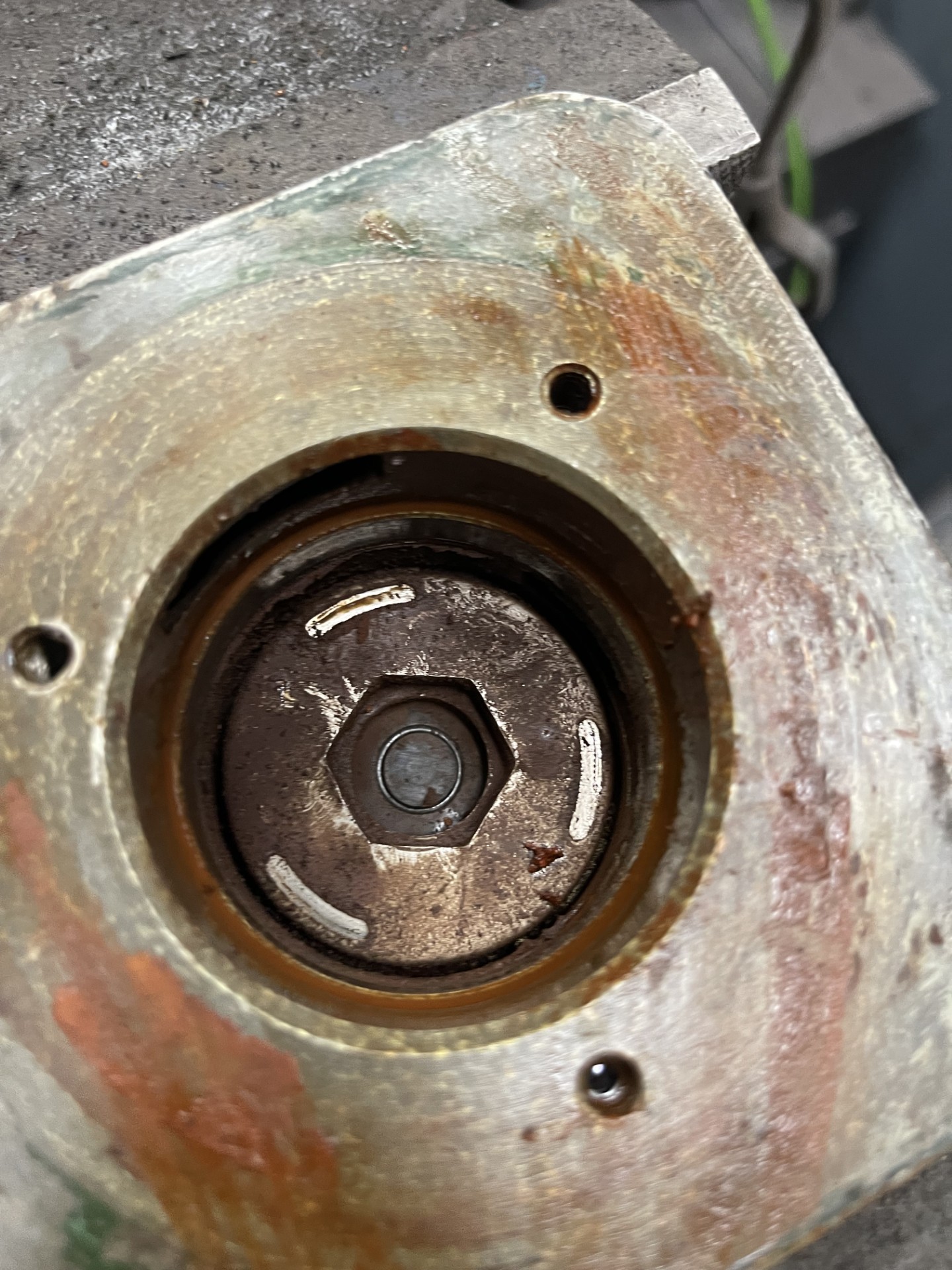

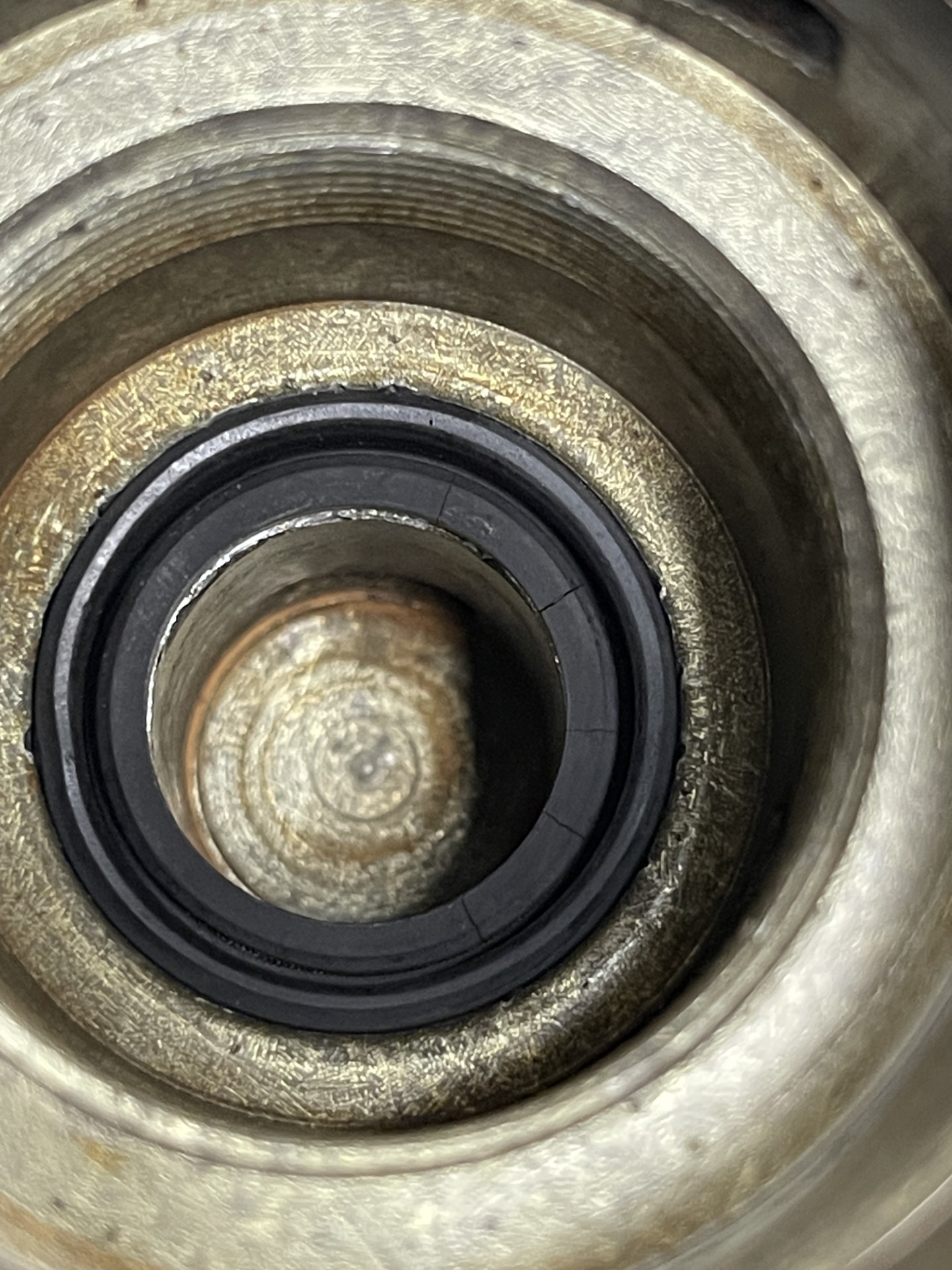

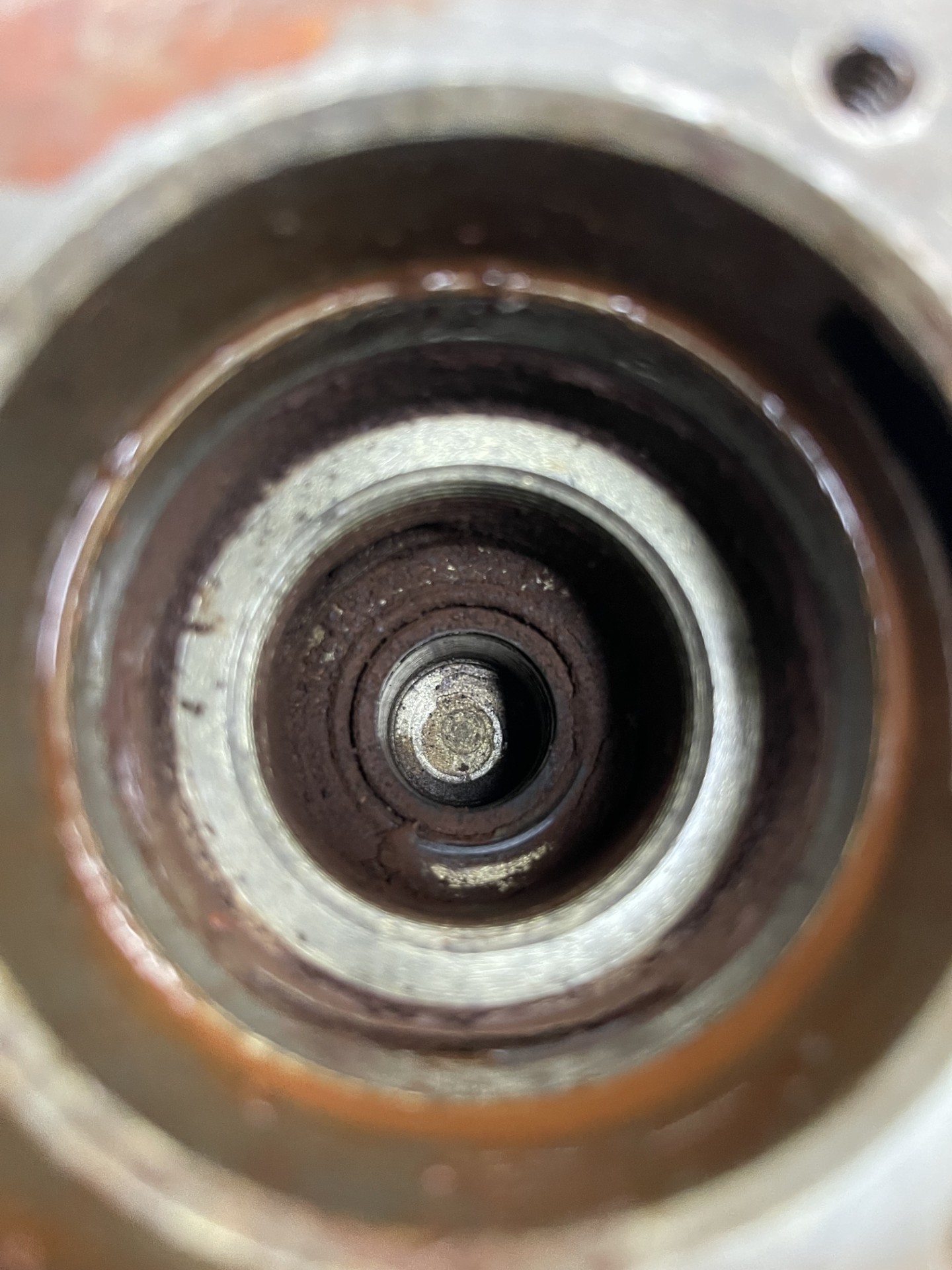

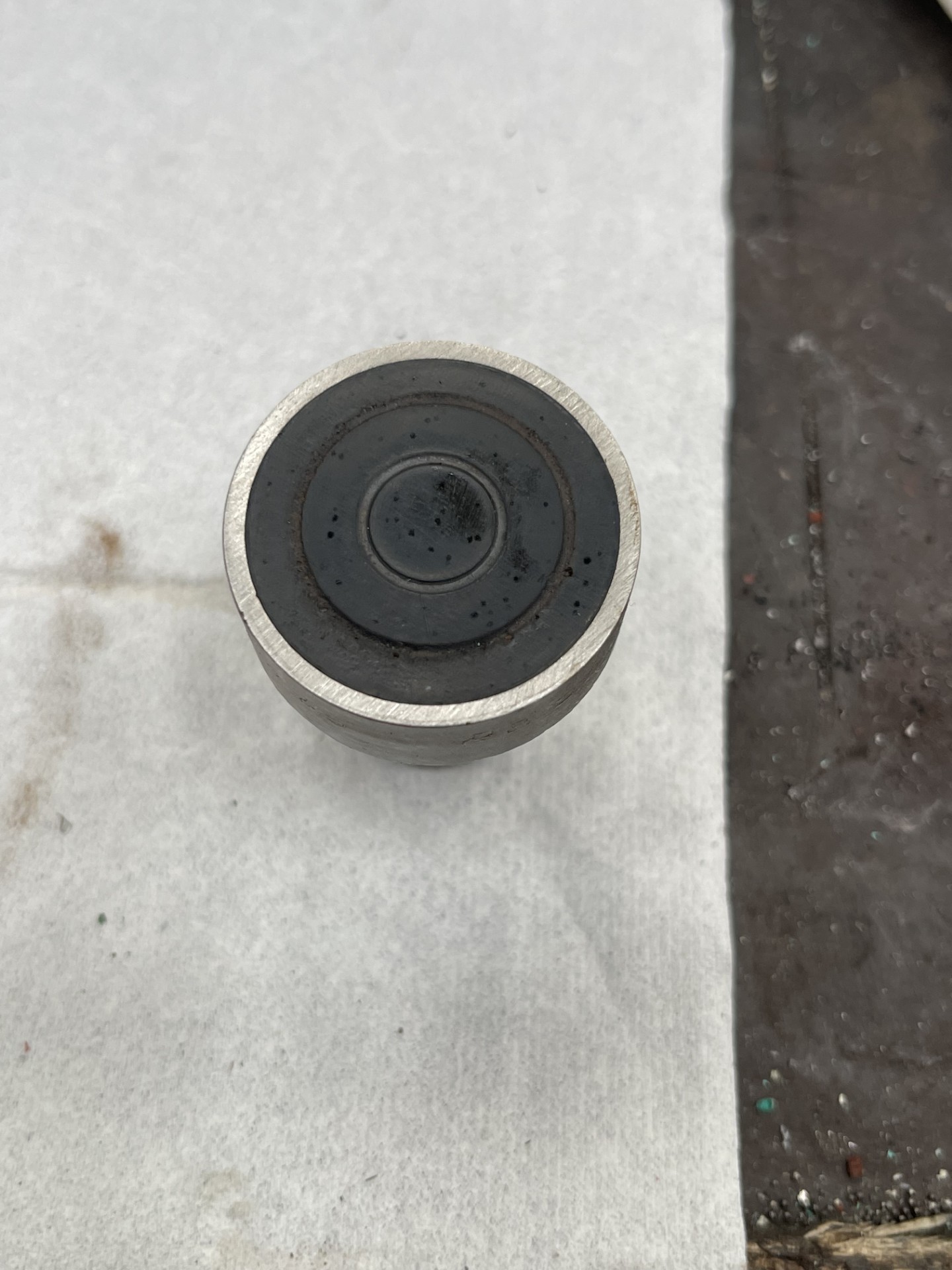

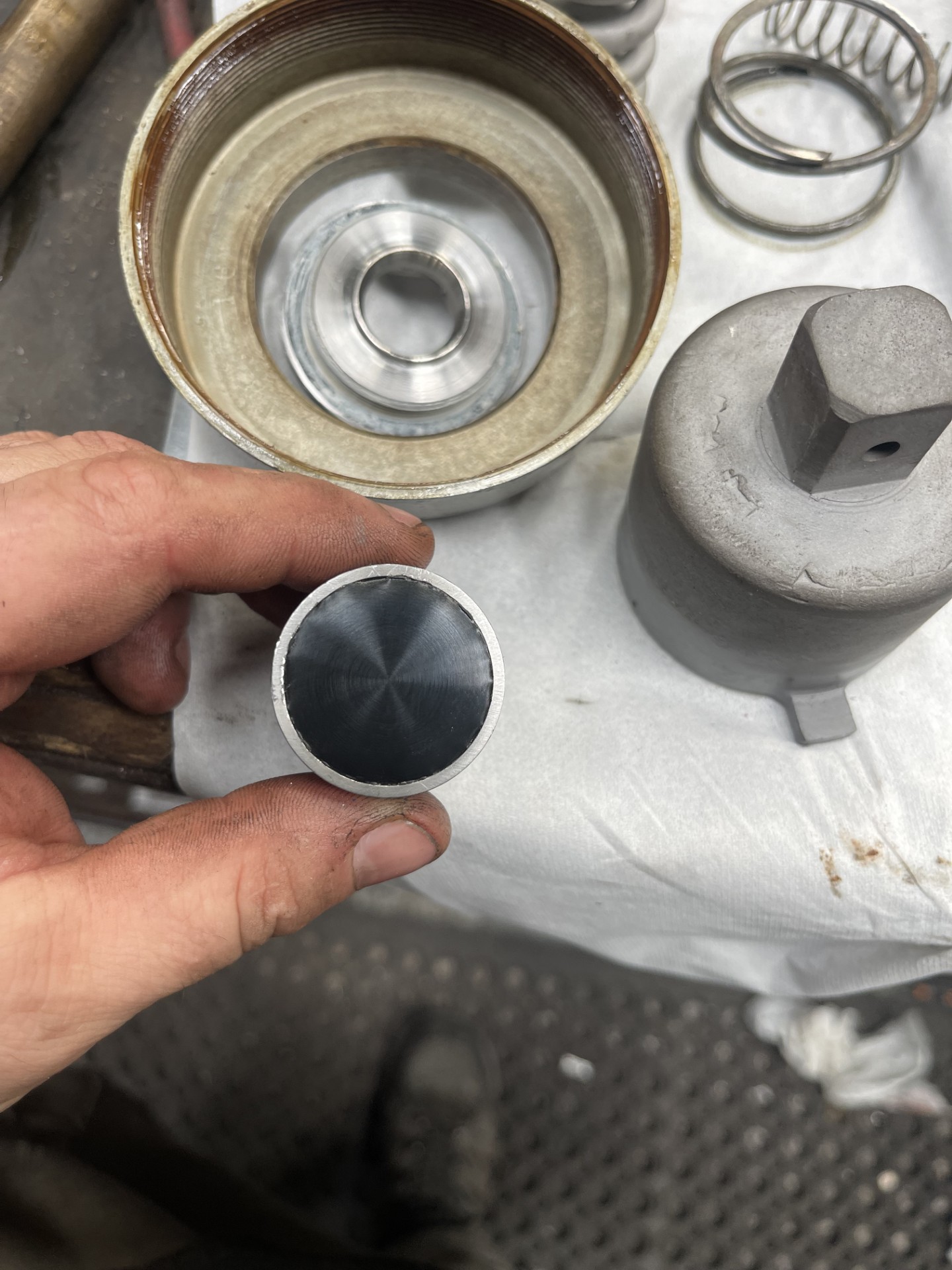

2 overhauled straight air valves were also installed.

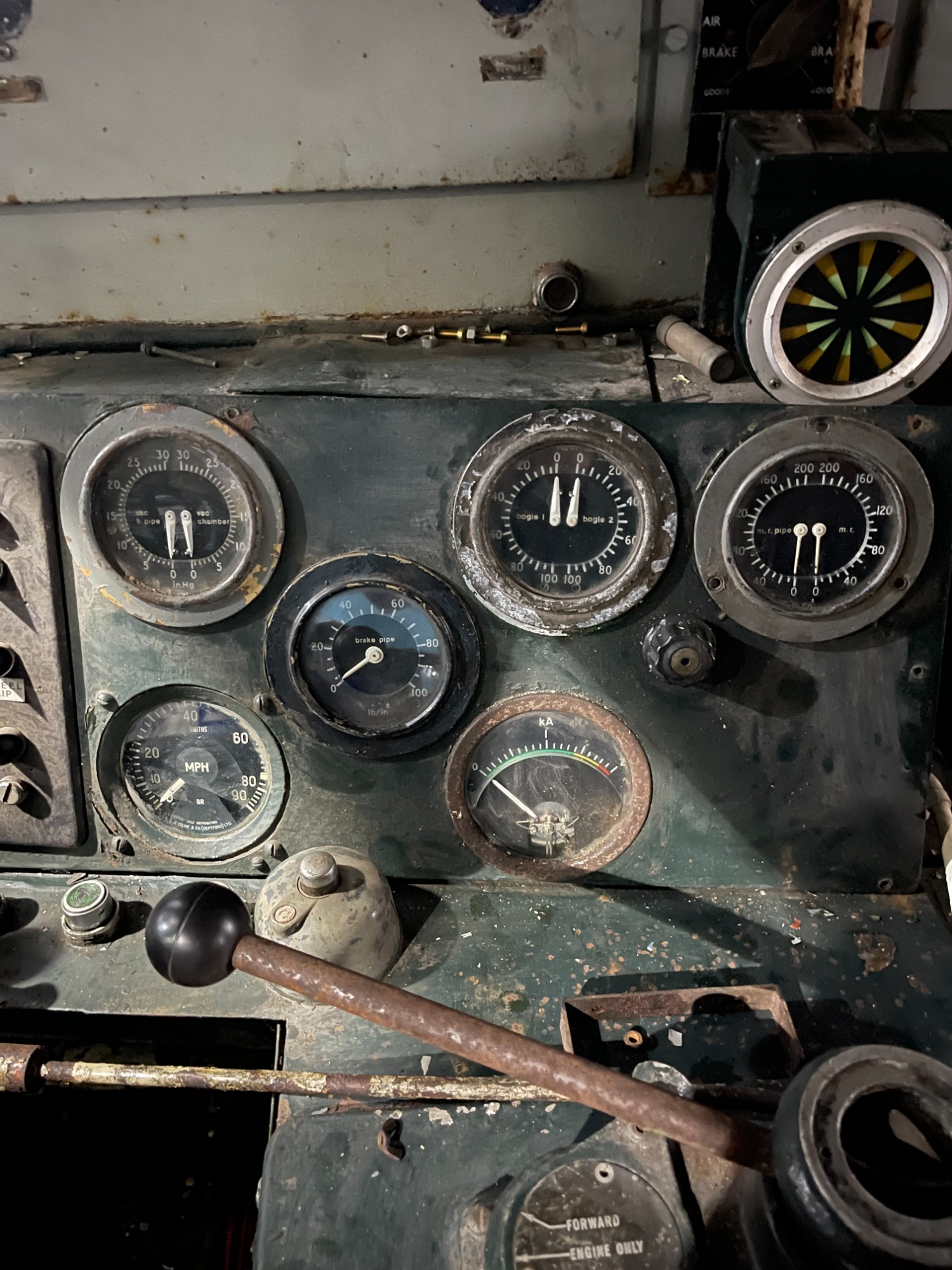

Cab was given a vacuum and the windows a clean.

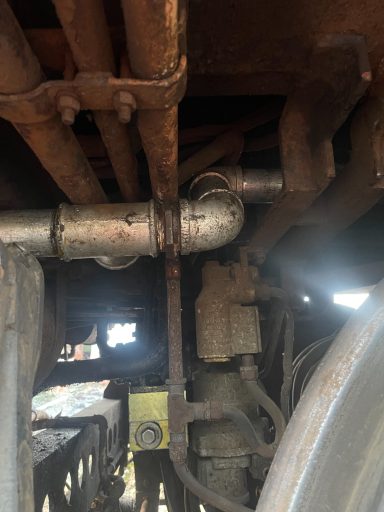

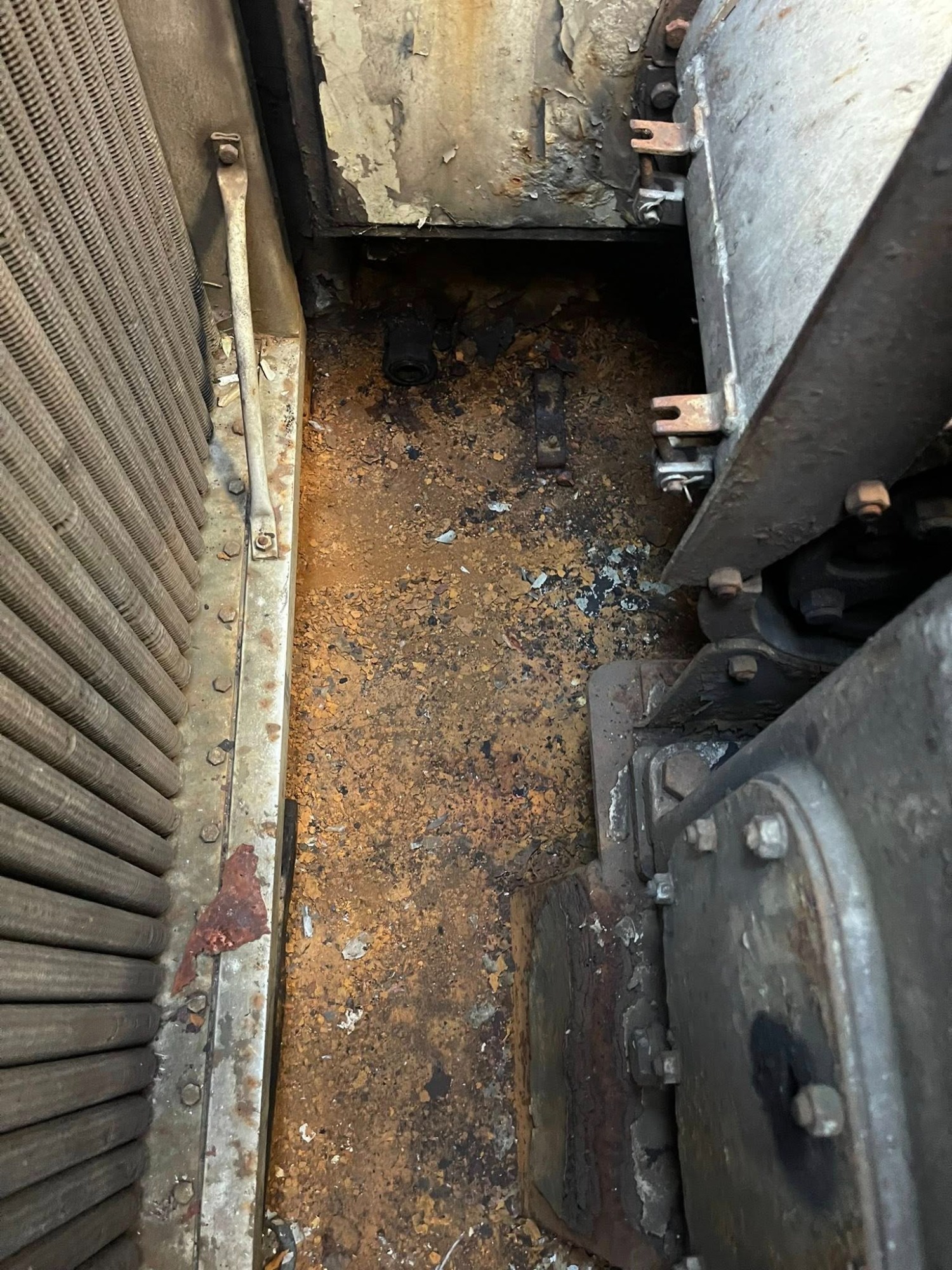

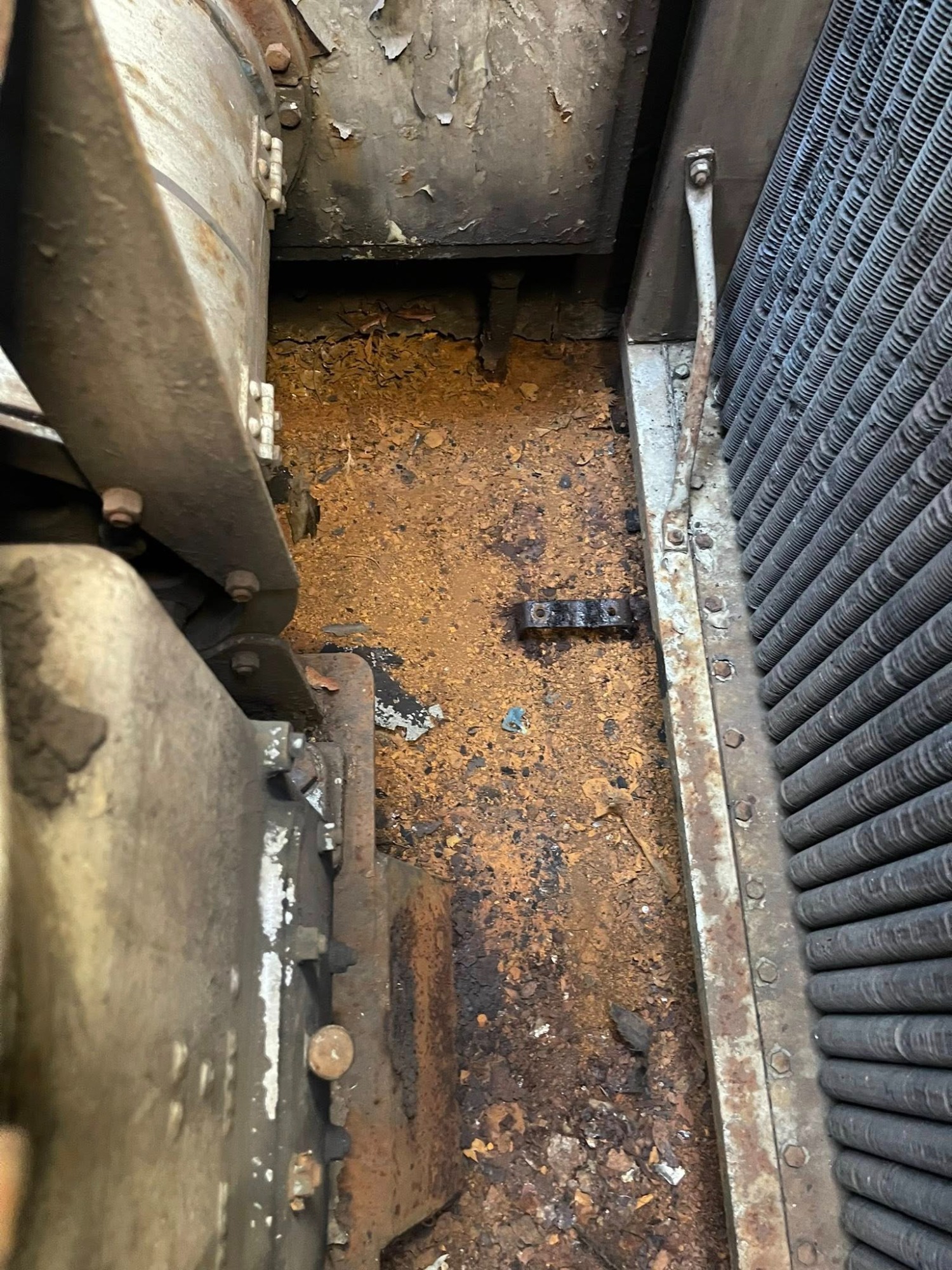

When we arrived on shed in the evening after the beerex we discovered a leaking pipe at the side of the generator that we don’t recall being there when we last checked, we did notice a very slow pressure drop on the loco whilst at the side of bury south waiting for the class 58 to bring the beerex into the platform but it wasn’t much of a concern as the compressor was able to maintain the pressure perfectly fine. When we got back on shed we could hear the air leak whilst the power unit was running, to hear a hiss with the unit running it would have to be a severe leak.

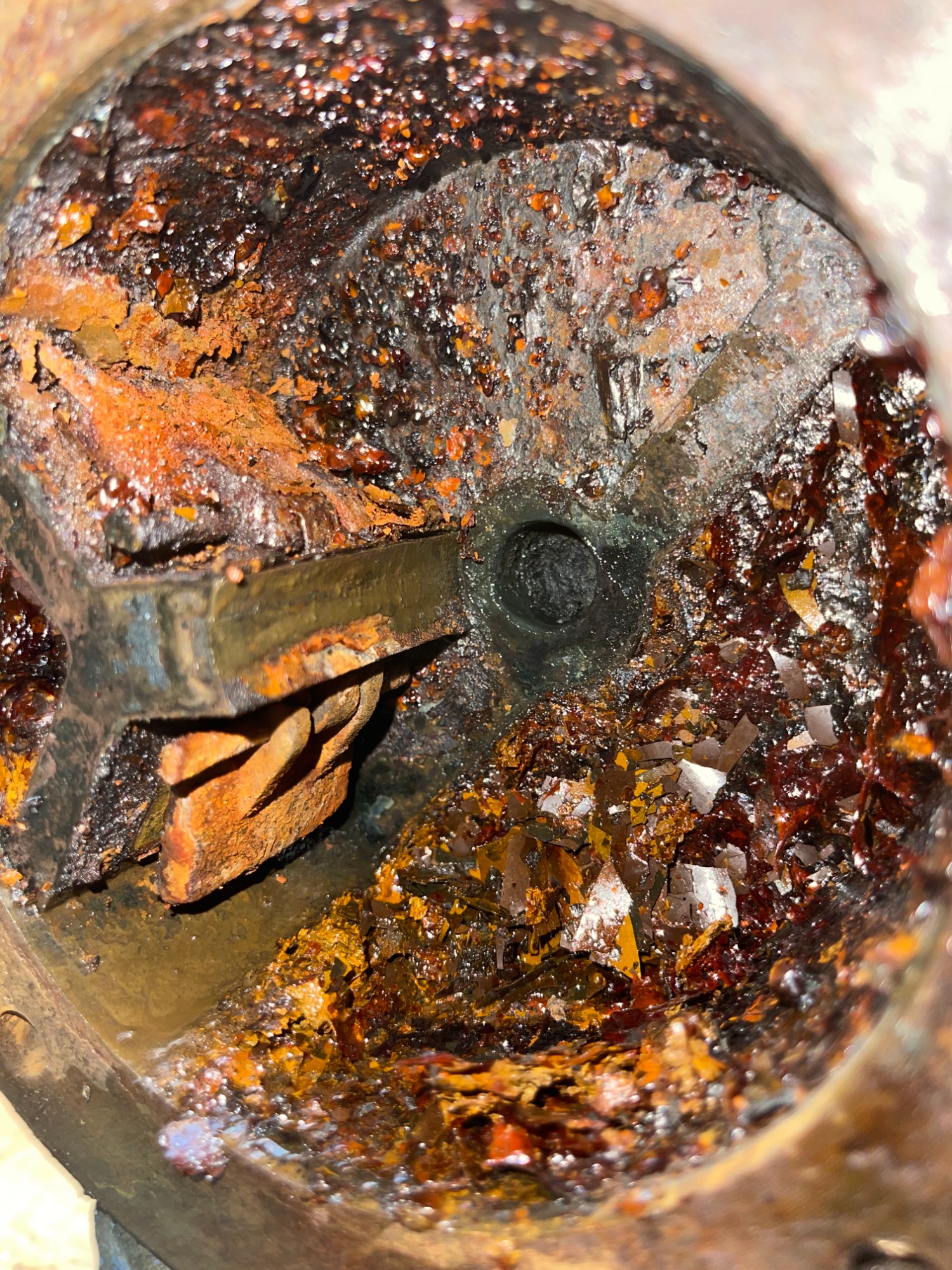

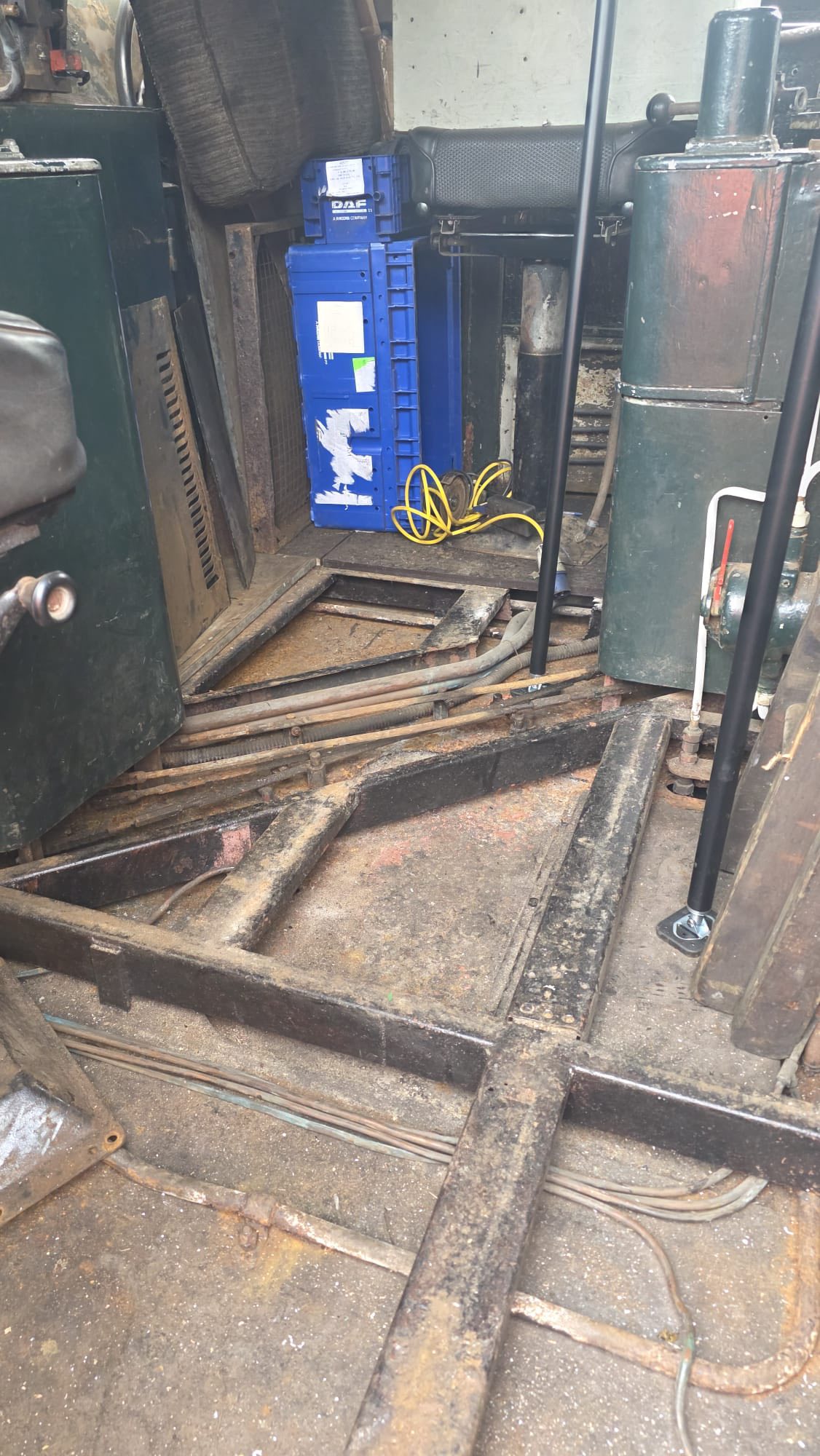

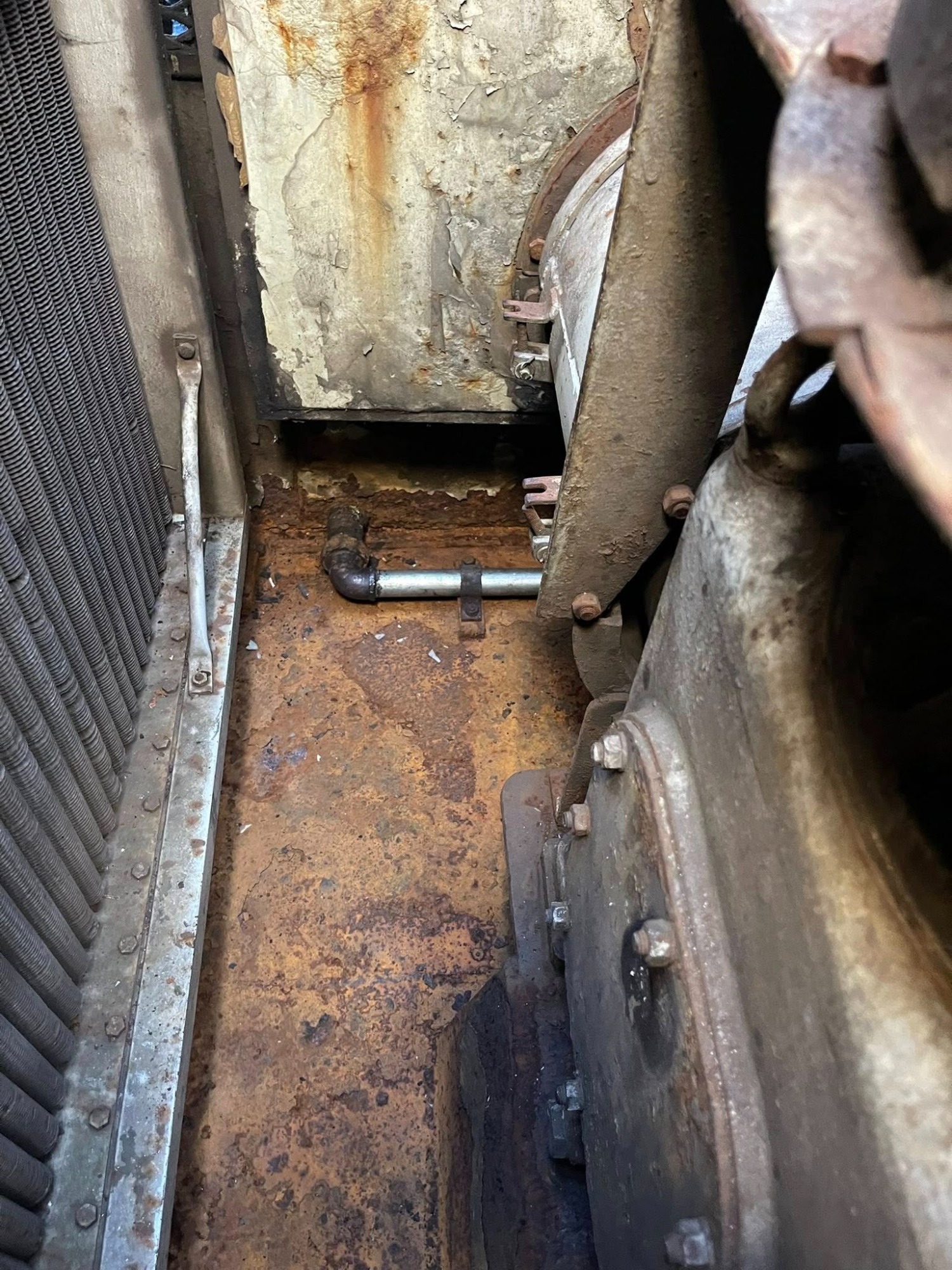

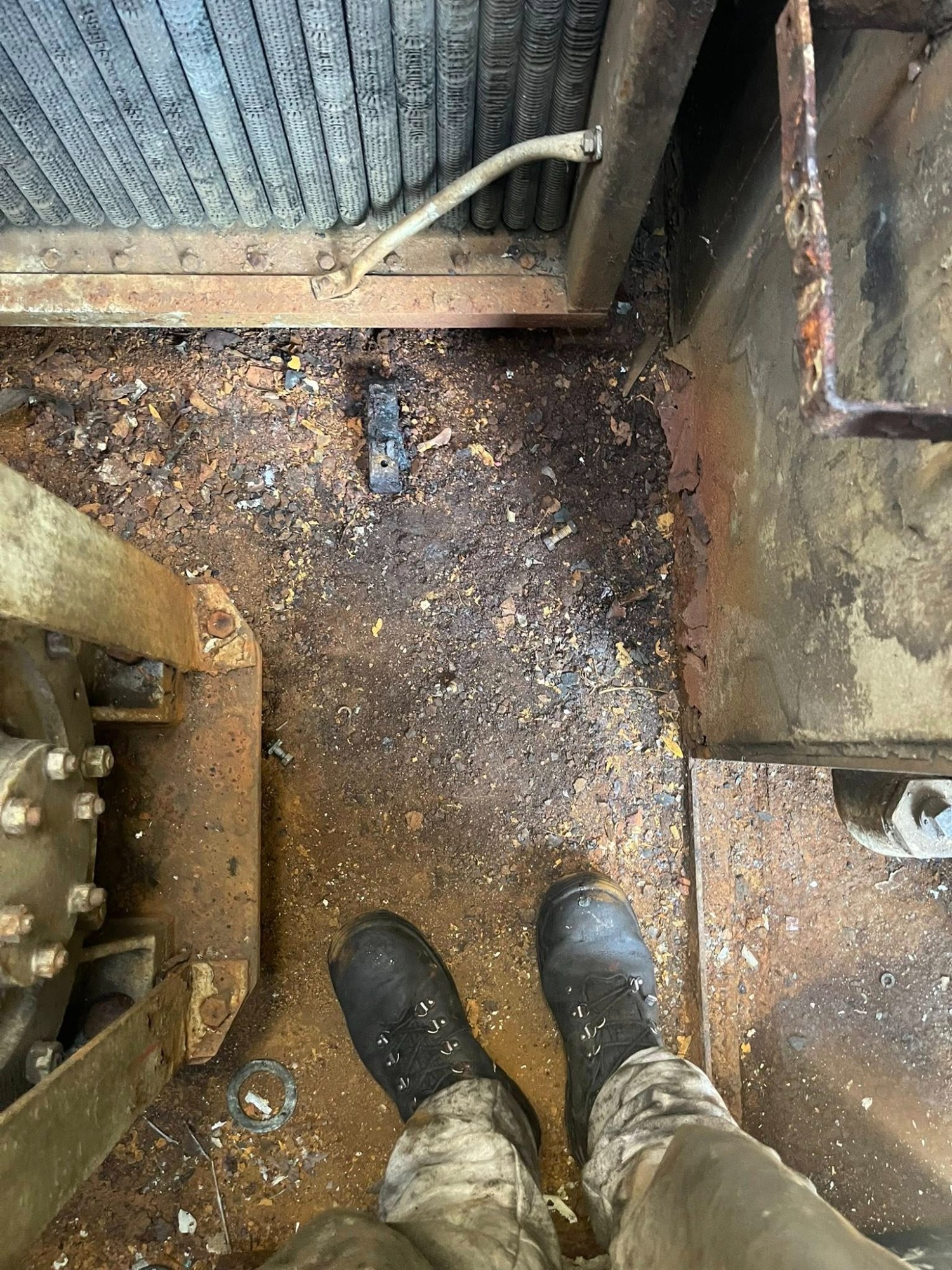

One of the pipes that goes through the floor had corroded, with the corrosion attacking the pipe over the years it eventually made the walls very thin and finally gave way, you could move the pipe with your hands and see the fitting ready to pop off.

Shane focused on that on Friday and had the floor out with new fittings ready to be installed today so everything was piped back up. Given the condition of the floor and a few fittings looking not far off the same state as the one that blown we decided to chop the floor and replace all 3.

After all of this was done we used the 08 to charge the air system on the 20 so we could listen for any leaks on the system and action it there and then without having the need to shut the 20 down and faff around, we can just isolate the pipes between the 08 and the 20 and crack on as needed.

The air system was fairly tight except a few union fittings that didn’t take much to tighten, we then set the pressure of the straight air valves and immaturely gave the horns a quick blast (as you do).

June 2026 Update

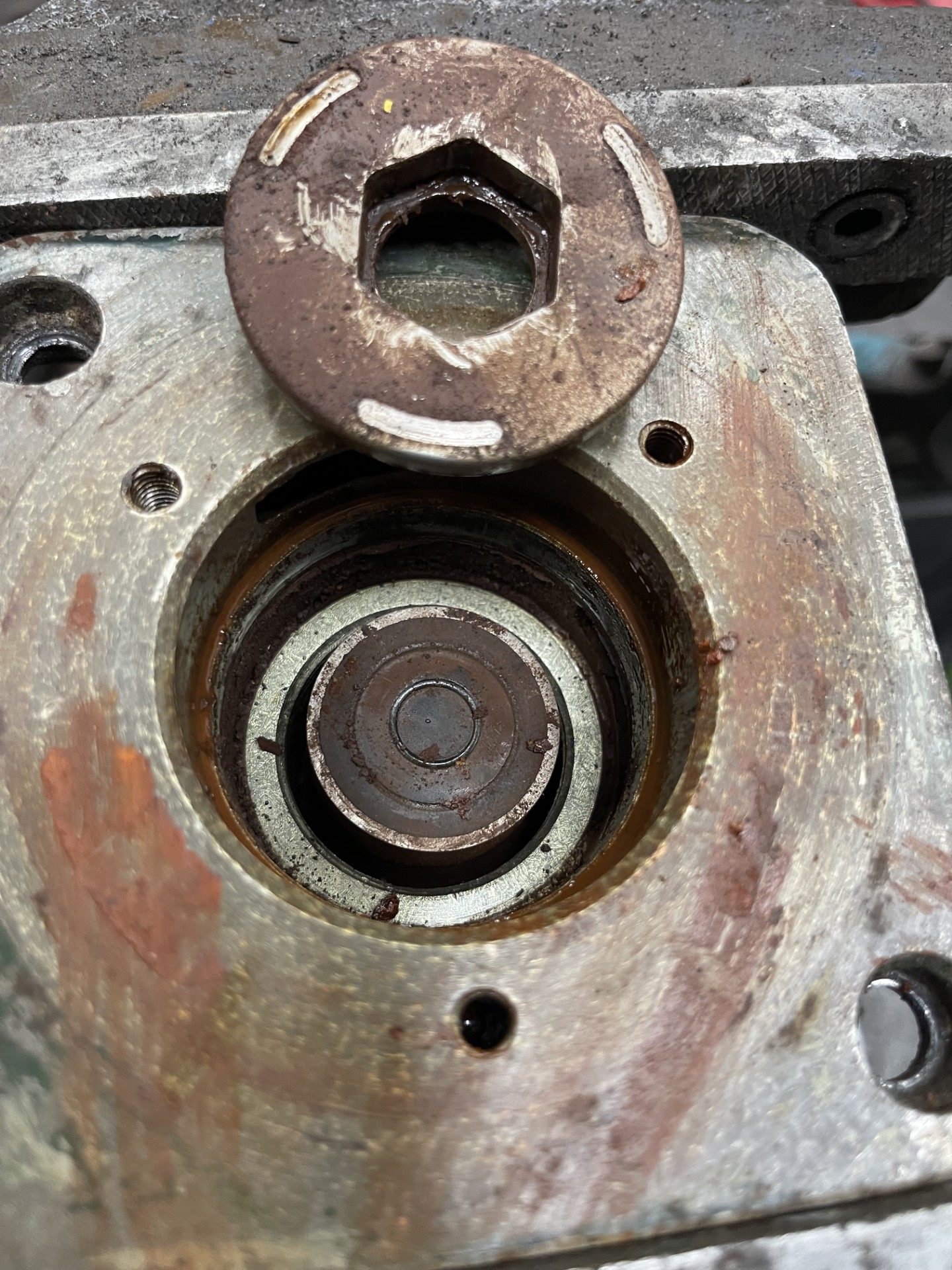

Following our first failure of ownership where we didn't even get off shed it was clear we had an issue, an issue that wasn't there when we first started the loco up. The compressor was the culprit, the high pressure side wasn't holding and failed to build any air. Fortunately after stripping it down, cleaning the bores and giving a light hone, this has fixed the issue and we're back to building air.

We felt we were ready to do a test run but the loco required at least an A-exam before we were allowed outside of station limits, thankfully Andy S was available to see to that mid-week. We had a few issues that needed addressing like adjustments of the slack adjusters for the brake rigging but it was nothing we couldn't sort on shed before the test run.

Friday morning we prepared just shy of 100t for the 20 and at around dinner time we set off up the ski jump ready for testing. We made it to the bottom of the ski jump and attempted to apply power as we climbed, the overload tripped and we lost power so we came to a stop. Brakes applied we tried to take power again and again the overload tripped. We popped the electrical cover off and quickly diagnosed an issue with the reverser. The reverser has 8 contactors altogether, when you throw the lever into a direction and take power it throws 4 contactors in, when you switch direction it throws the other 4 contactors in and takes the other 4 out. One of the pins that hold these together had sheered and wasn't holding the contactor off so when it made contact it thrown the fault up.

A quick temporary fix was done to allow us to carry on testing, if it was to happen again we were ready to abandon the test run and head back to shed.

First run was nice and steady all the way up broadfield with little increments of power as we starting climbing up the bank, we got to spoutbank farm and we were at full throttle making one hell of a racket, looking back we saw years of crud that had been sitting nicely in the exhaust exiting its way out of the top.

First run successful so Andy S and Malc took us back to Bury so we could check the loco over and get ready for another run. Oil pressure was sitting happily at around 56psi, no signs of oil or coolant leaks and the coolant sitting just shy of 3/4 full.

Departed again and no issues with the ski ump, again full power all the way up from the bottom of the incline to the top of the bank. Once back on shed we checked the loco over again and still no signs of anything to worry about, a successful test run was complete.

We do have a couple of jobs that need attending to before moving forward.

  • Nose end horn intermittent.
  • DSD no2 not working
  • Windows need sealing
  • Reverser issue
  • Field divert issue

27th June

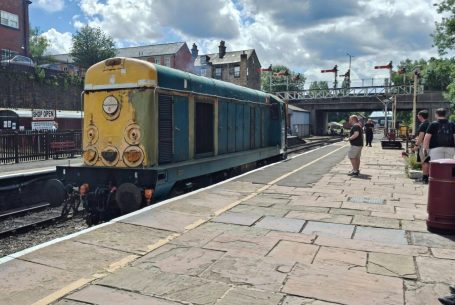

We managed to fix the issues listed above and we did try to keep the test run as quiet as we could, but as expected for lucky few who were onboard D5054 on this date had the chance of claiming a few miles behind the loco and it quickly got around on social media. With the gala just a few weeks away it was clear what the intentions were.

20069 jumped ontop of the 13:20 service to Heywood and completed its first passenger service test run without any major issues. One thing we didnt do was test the compressor and the VAC system on a service train, although results were good on shed it's slightly different trying to blow up on a 4-5 coach train.

Footage of climbing the ski jump can be viewed on Youtube or on the Bury Chopper Group facebook.

May 2026 Update

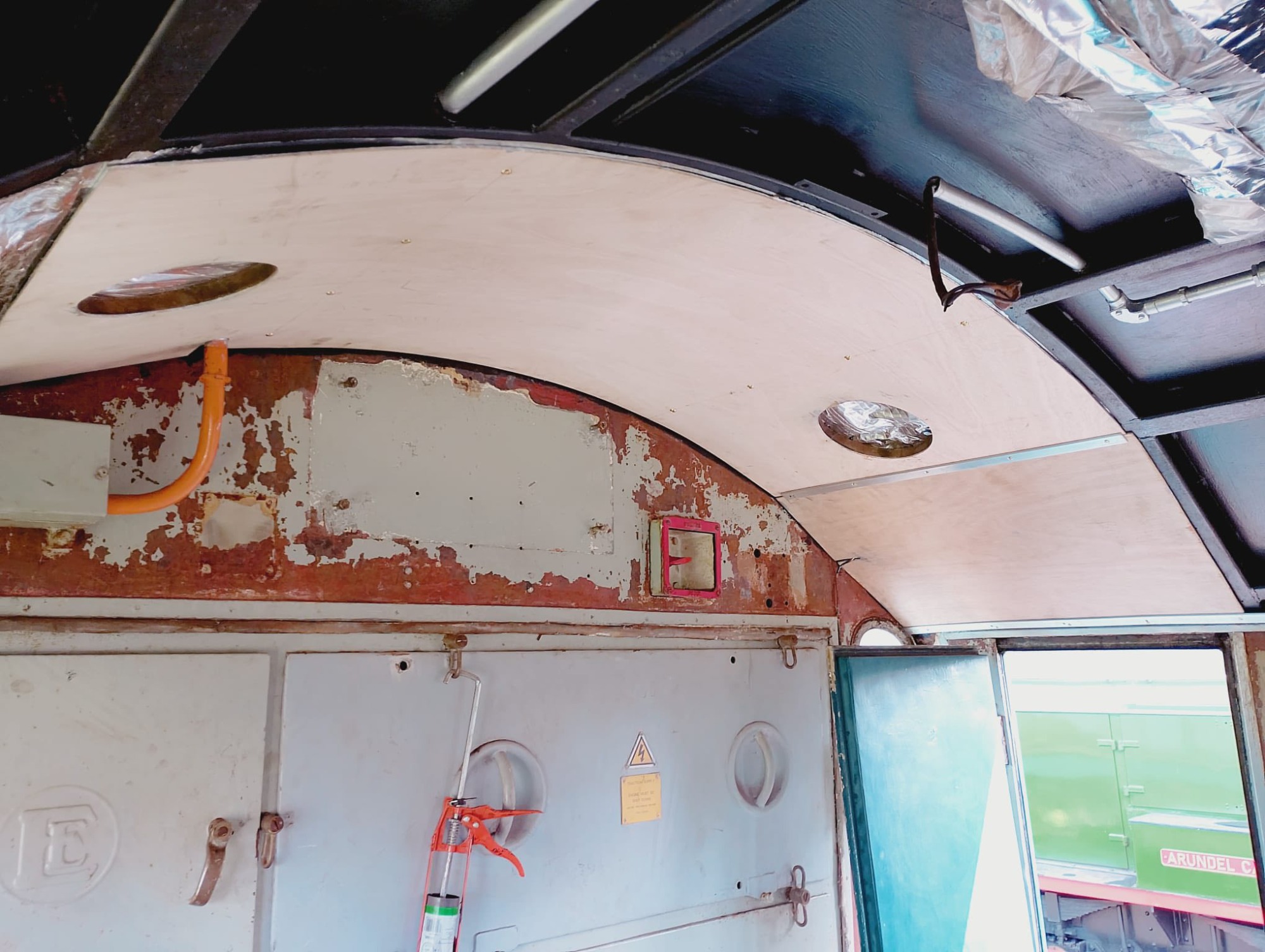

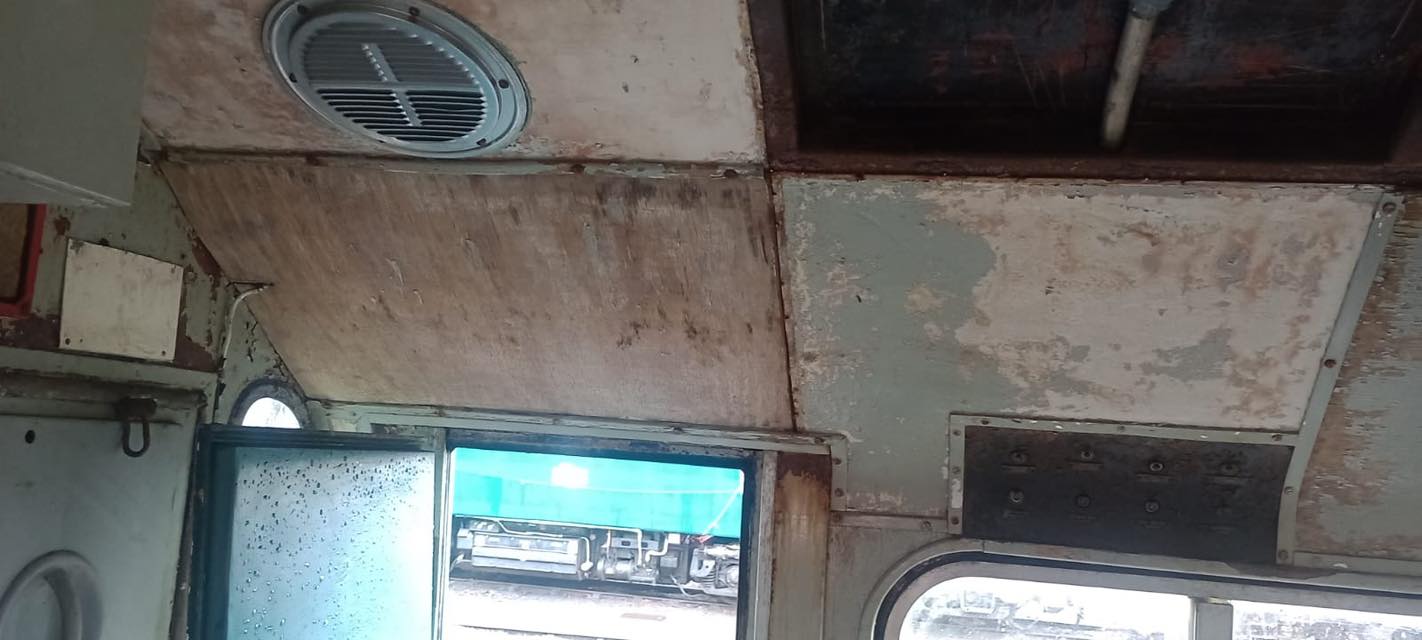

Cabs

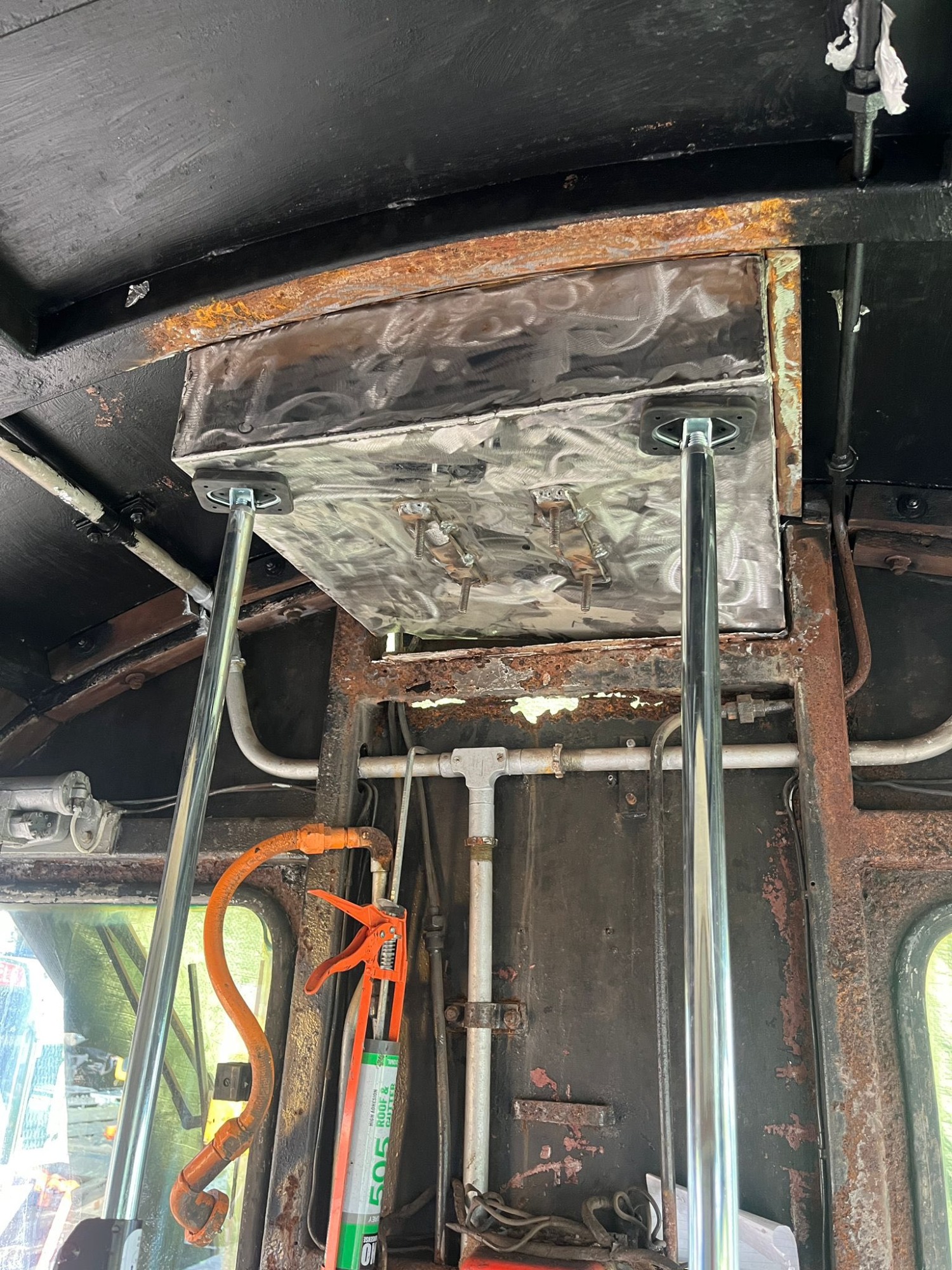

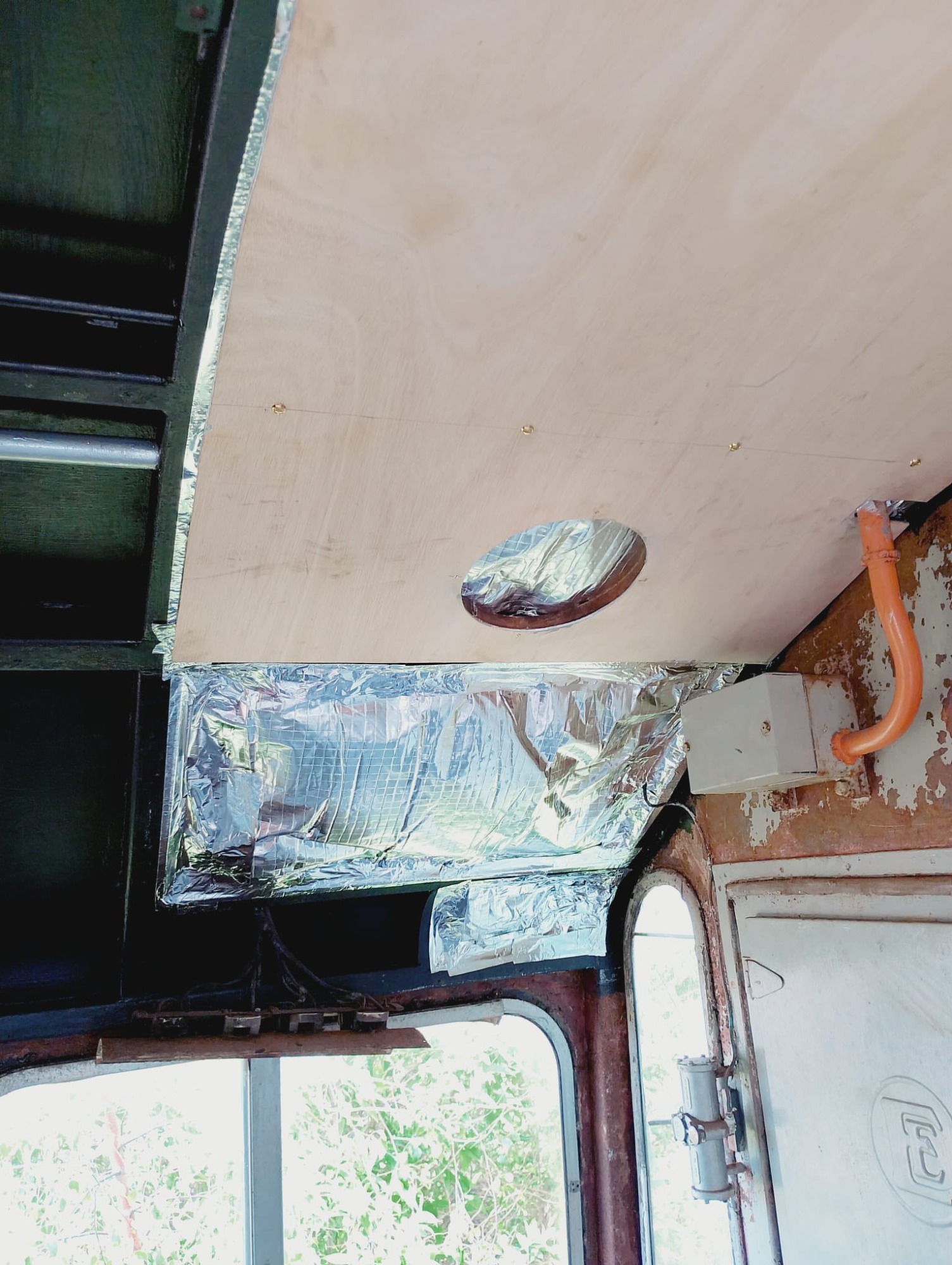

  • All of the internals of the roof has been ripped out, wire brushed, treated and painted. We're now in the process of insulating the internals and installing new wood.

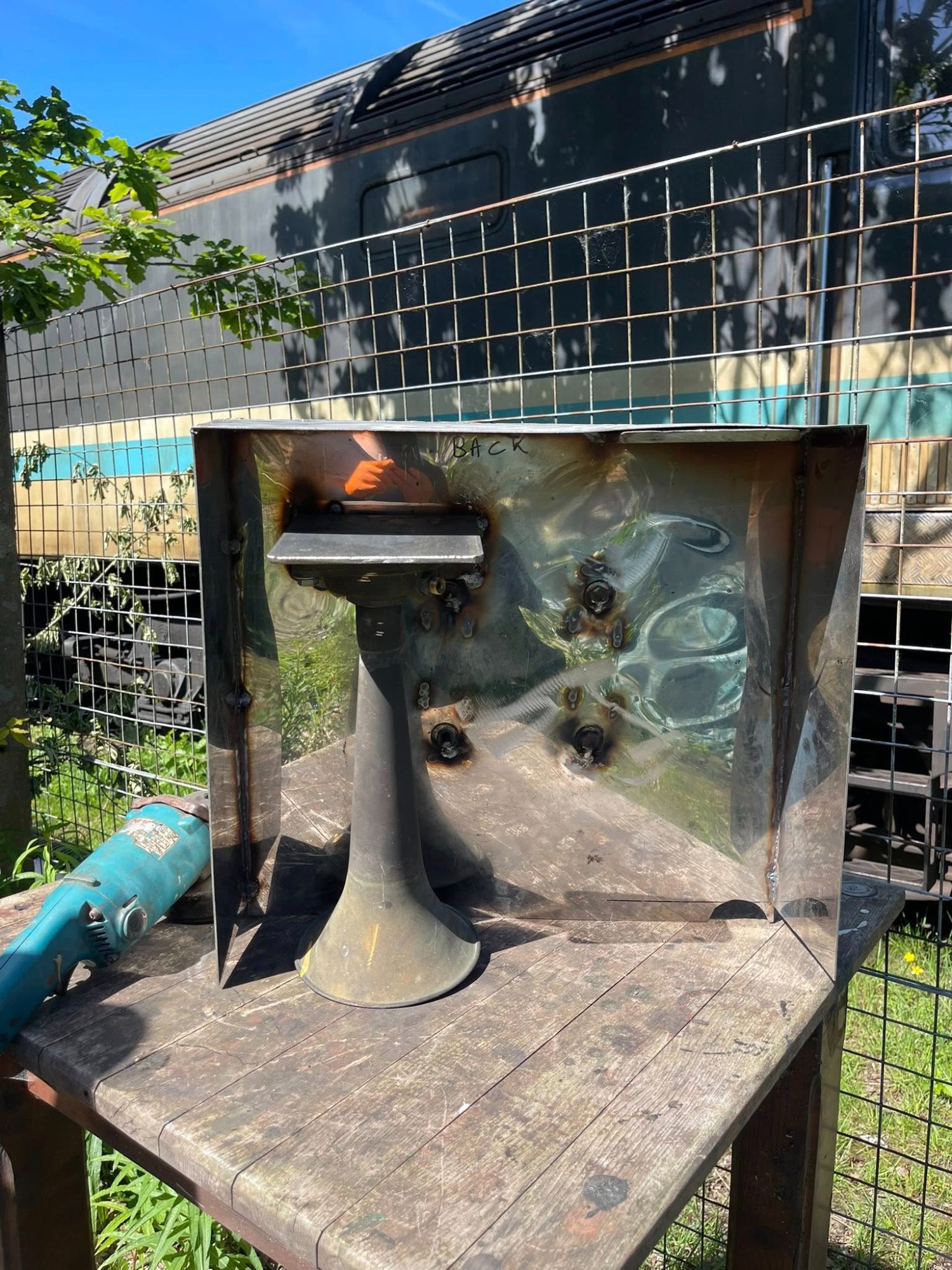

  • Horn box fabricated and put together, test fitted and is ready to be welded into place.
  • Flooring has been removed to check the condition underneath, all looks to be in decent condition. We're still in 2 minds on what to do with the flooring whether to replace or try to fix the old stuff.
  • Door locks fitted
  • Ongoing issue with the steel work on the back wall, we're temporarily filling in all of the gaps to stop water ingress but we do plan on chopping this out once we've completely installed the roof horn box as that's where the water is making its way into the cab.

Everywhere else

  • The faulty AVR has been removed, fixed and is now working as it should.
  • All pipework underneath the loco, missing valves and misc items have been accounted for and checked.
  • Compressor checked over and operates as it should, no issues with building air pressure.
  • Exhauster checked over and operates as it should, no issues with creating vacuum.

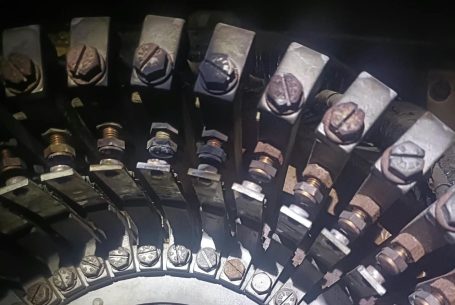

  • Traction motors checked over, brushes free'd off and missing brushes were installed.
  • Brake system now responding to all inputs using both straight air and train brake on both desks.
  • Load reg motor fixed, loco now takes power and gives amps required from the power handle.
  • Coolant pipes replaced in the rad room.

24.05.2026

After a very productive few weeks and milestones achieved last weekend, Steve and Mat decided to do a little cheeky working day midweek to see if the exhauster would create vacuum, the brake system was still operating and more importantly to see if the loco would take power. With the BIS in, the loco fired first time from the cab controls without the need of any wiggling of any contactors or switches. Once the air built up, the brake selector switch was flicked over to vacuum and the vac system started building. A pull of the power handle saw the amps creep up nicely and happily dropped back down once the power handle was moved to the OFF position.

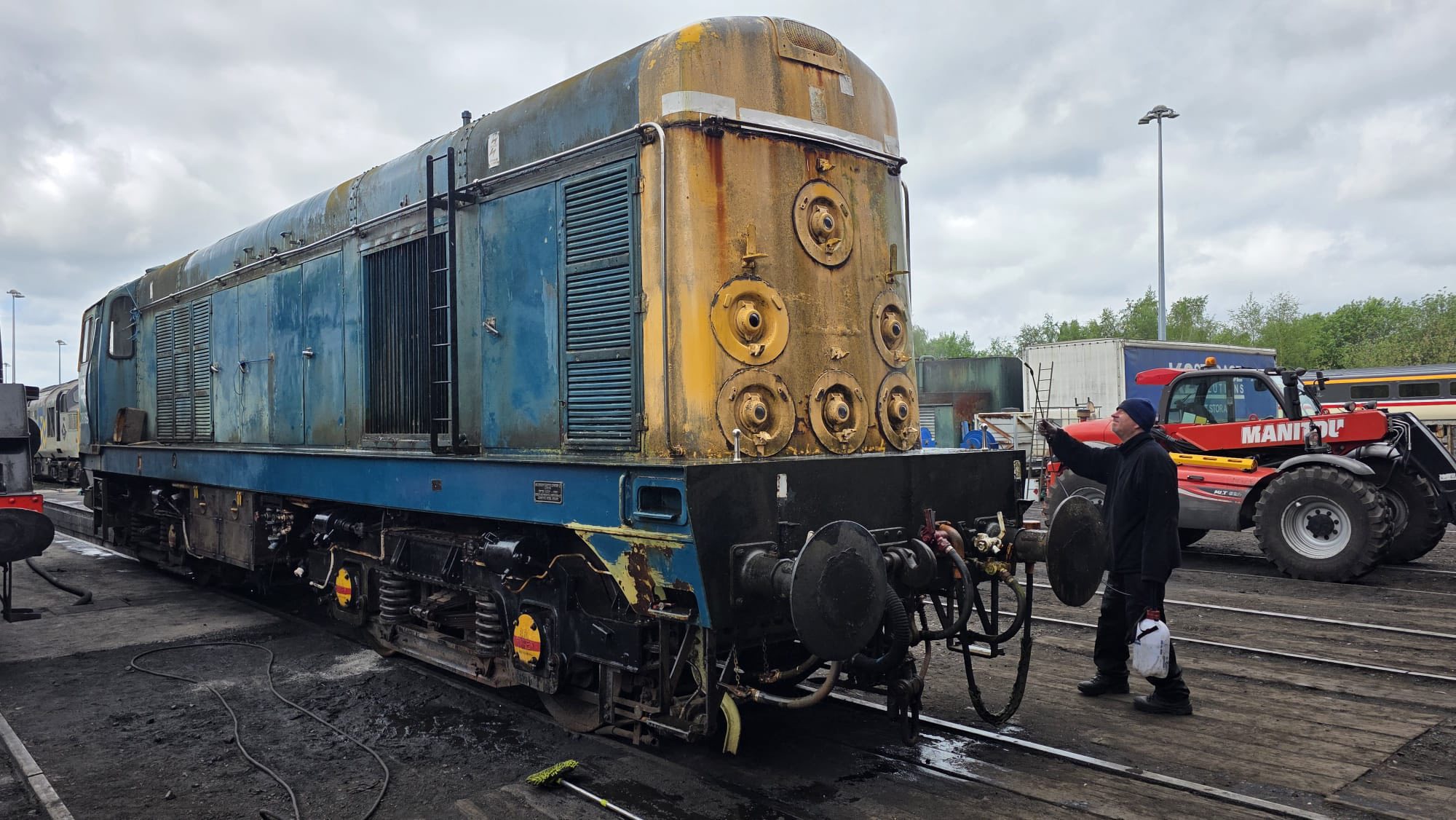

Saturday we had quite a few members available and the weather was wonderful so it was decided to finally give it a clean and see what the paintwork was like underneath, fortunately it’s not as bad as we thought. Carrying on from Thursdays meet, Mat and Steve decided to try for more power but unfortunately hit an issue. When moving the power handle to a position that demands amps it was letting you have it, but it wouldn’t give you anymore than 300 amps. We just about made it back onto shed from shunting down the yard where we change the points to go onto a pit road, more investigation was needed. Once over the pit and shut down, Andy T and Ade started on the nose end whilst Mat and Steve had a nosey around the load reg. It was quickly diagnosed that the load reg motor wasn’t working, Steve worked his magic and within the hour the motor was back in. Fired back up and that issue had been fixed. The loco moved around the yard for around 2 hours with no issues with the braking or power demands. The class 56 needed to be moved to the top of the yard later on in the day so the 20 was used to drag it around. Andy S was on the 56 with it running for insurance purposes, more so to stop us joining the metrolink network just incase we needed his assistance. Plenty of power and braking tests were performed dragging the 56 through the sidings, happy to report all seems well although more testing is required to be satisfied the system is working as it should.

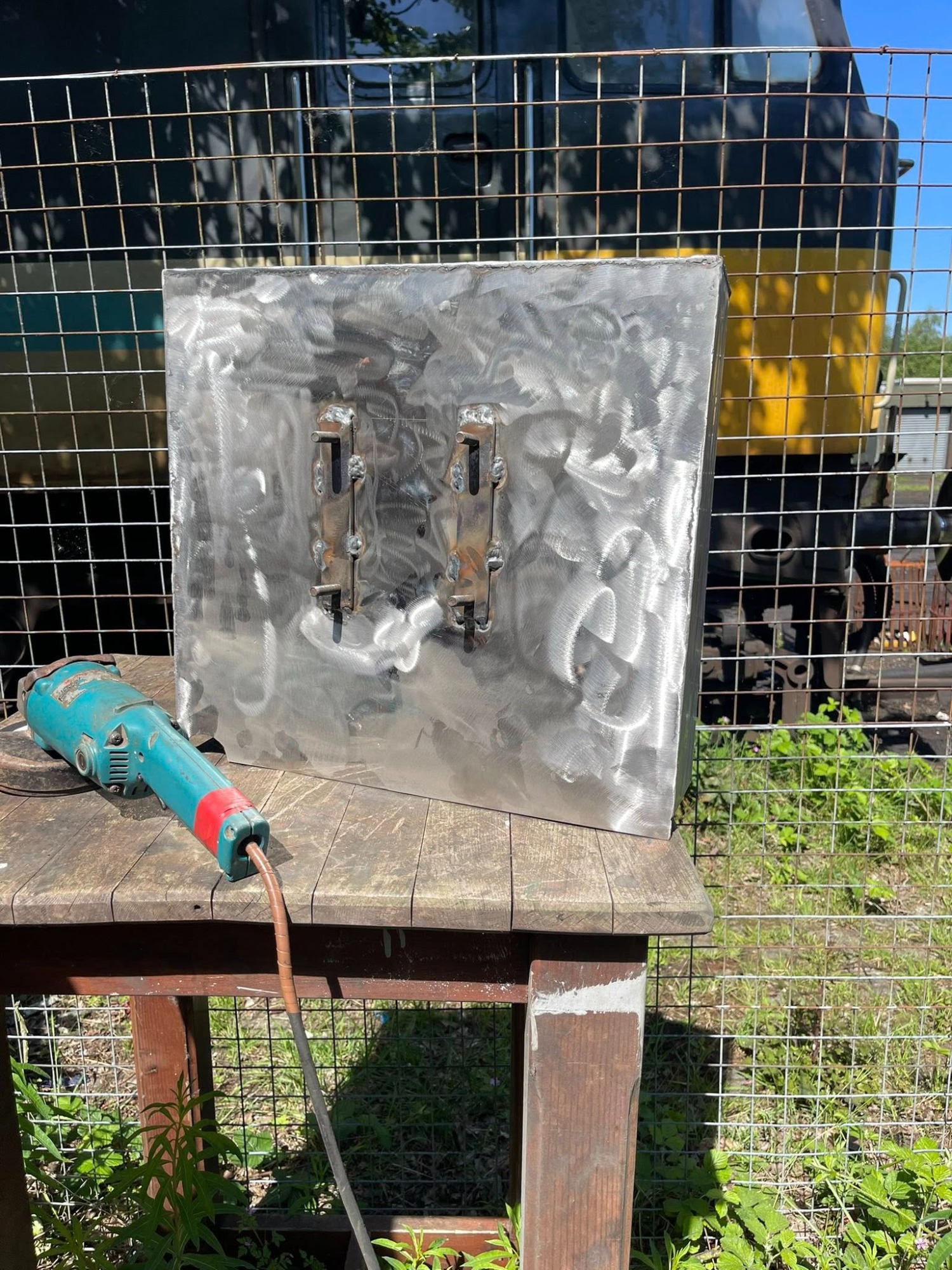

Shane is making really good progress with the cab horn box, it’s all welded together and the horns have started to be drilled and secured in place.

25.05.2026

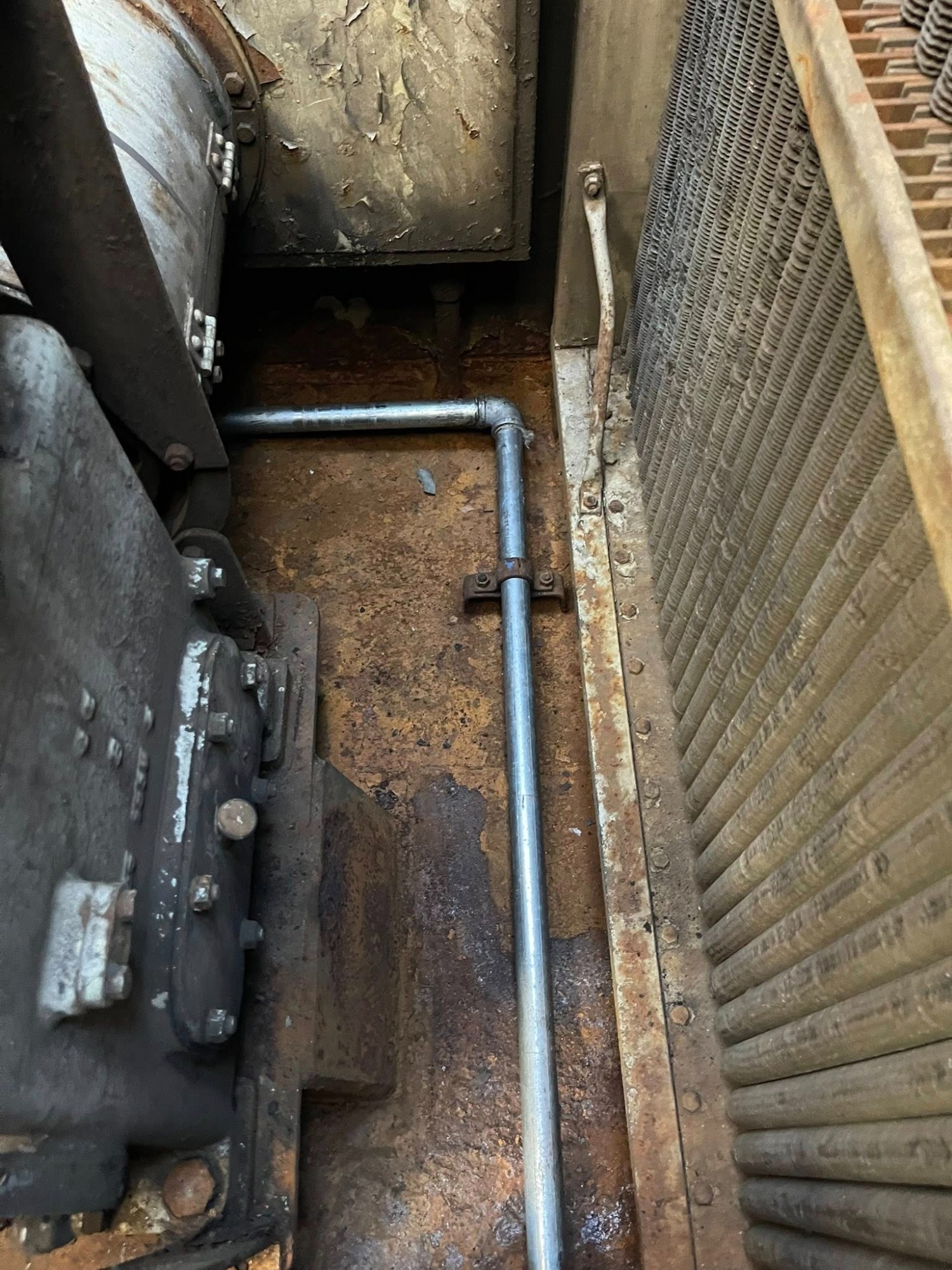

We’ve been losing coolant from the header tank and we assumed it was an air lock, this should have disappeared fairly quickly but the coolant loss remained so it was clear we had a leak somewhere. The leak was found in the radiator room on a pipe that goes from the header tank into the engine room. This was all corroded so the full lot was stripped out and replaced. As soon as the fitting was undone from the top it twisted off with not much steel left on the walls of the pipe. Whilst the pipework was out Jamie gave the radiator room a vac out and got rid of the layers of crap that had been sitting there throughout the years. All in all a very successful week but still lots more to do before we decide what's happening going forward. The loco does'nt look too pretty at the moment but mechanically everything appears to be working and responding exactly how it should be.

January 2026 Update

  • All brake cylinders have now been fully overhauled, with nothing major to report.
  • Steve continues to make good progress on the electrical side of the locomotive, methodically checking systems throughout. It’s a time‑consuming and sometimes painful process, but essential work that must be completed before testing can begin.

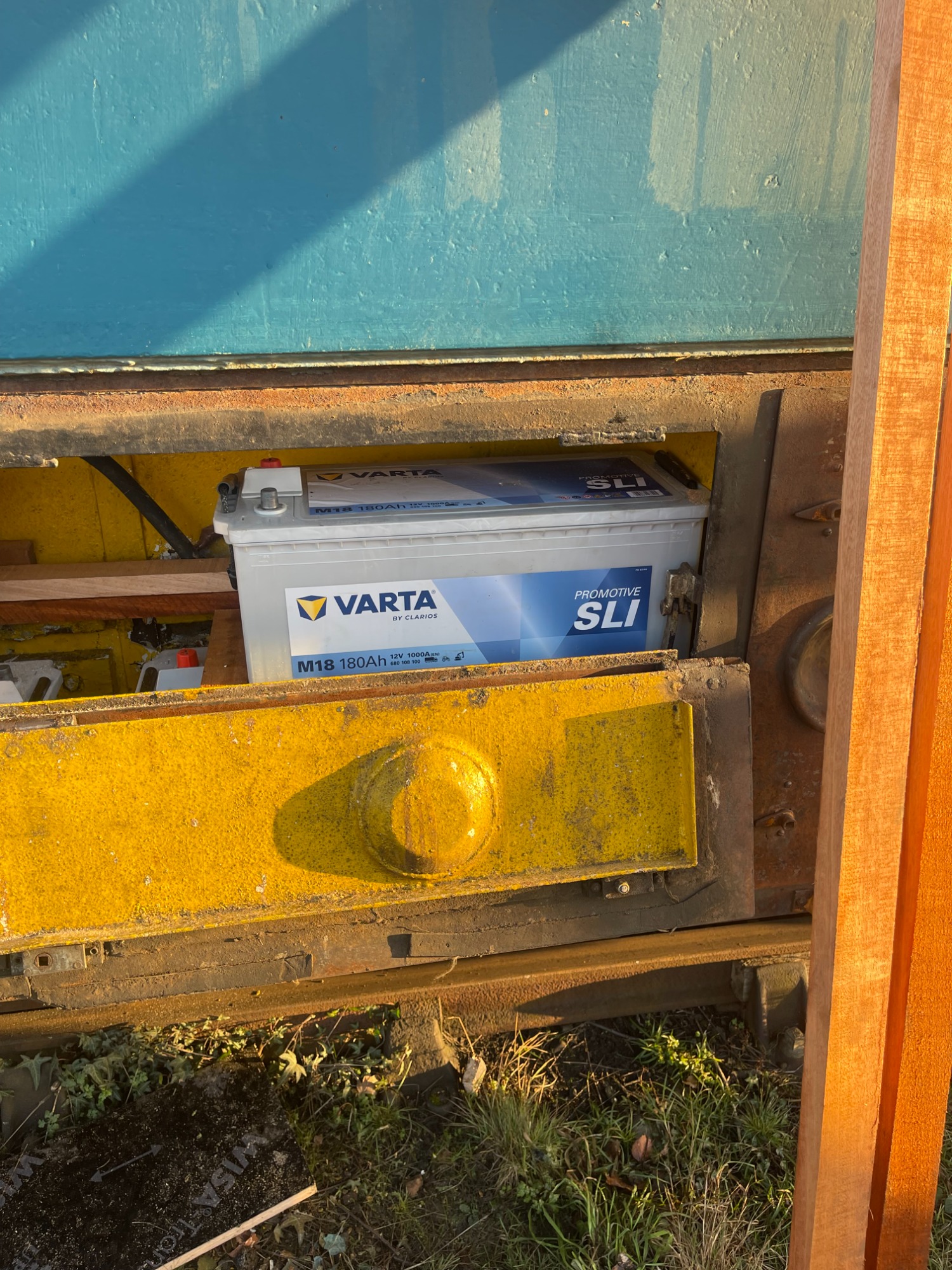

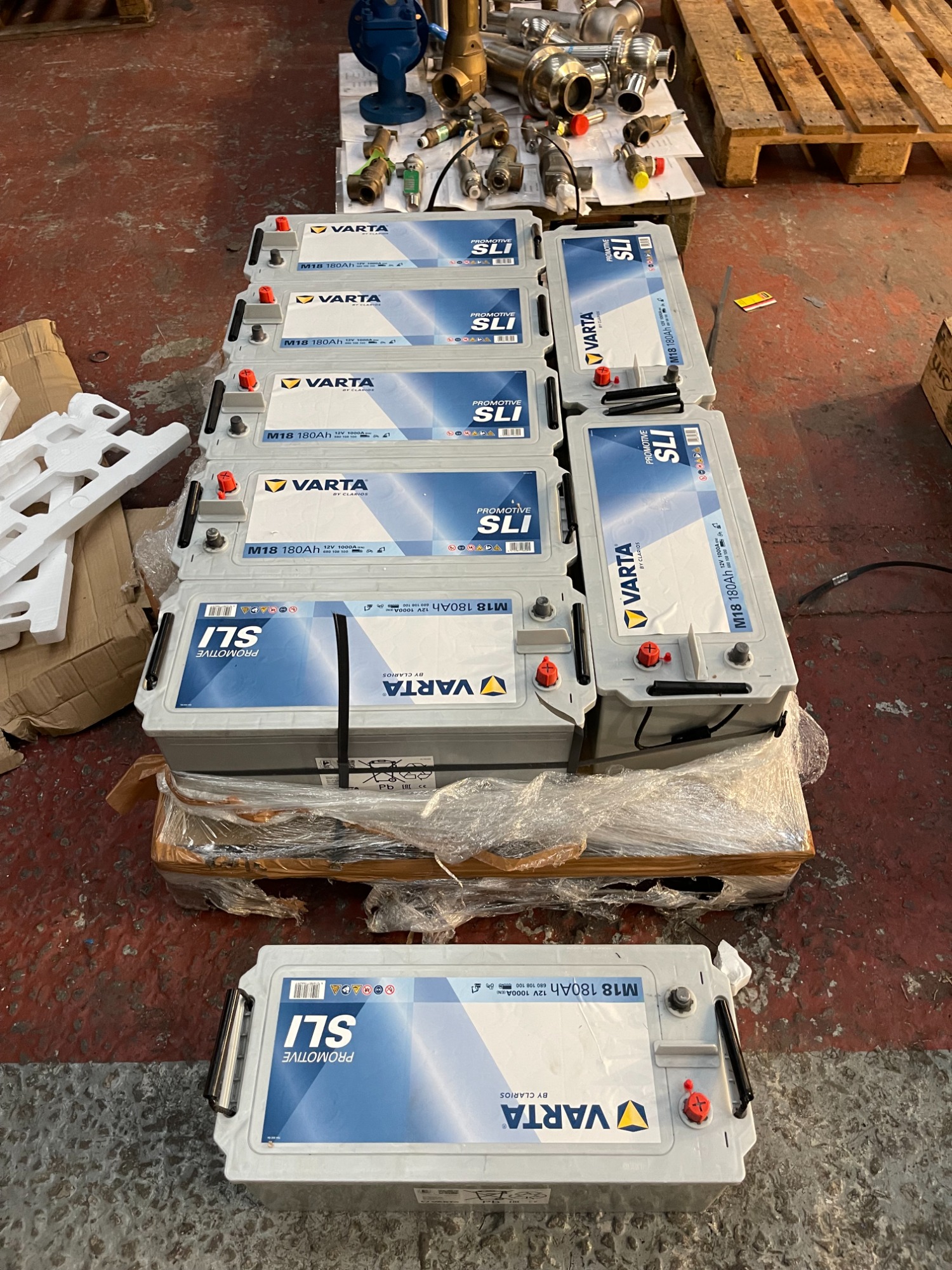

  • The batteries arrived toward the end of December and have now been installed, along with a provisional design to keep them securely in place. We’re hoping to have these fully wired in before the start of February.
  • The 2" VAC pipe running the length of the locomotive underneath was found to be missing, but this has now been reinstated. Once an isolation valve and strainer valve are fitted, the vacuum side of the locomotive will be complete.
  • All brake valves that were missing from underneath the loco have now been recovered and installed. These were included with the sale of the locomotive but had not previously been fitted.

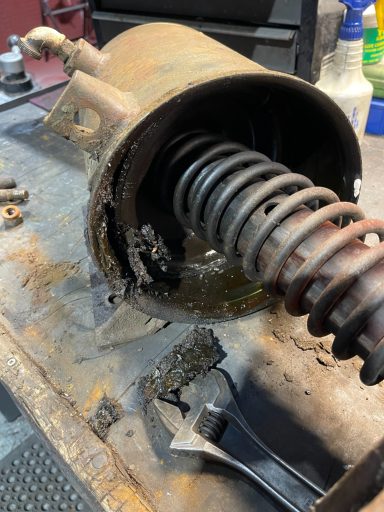

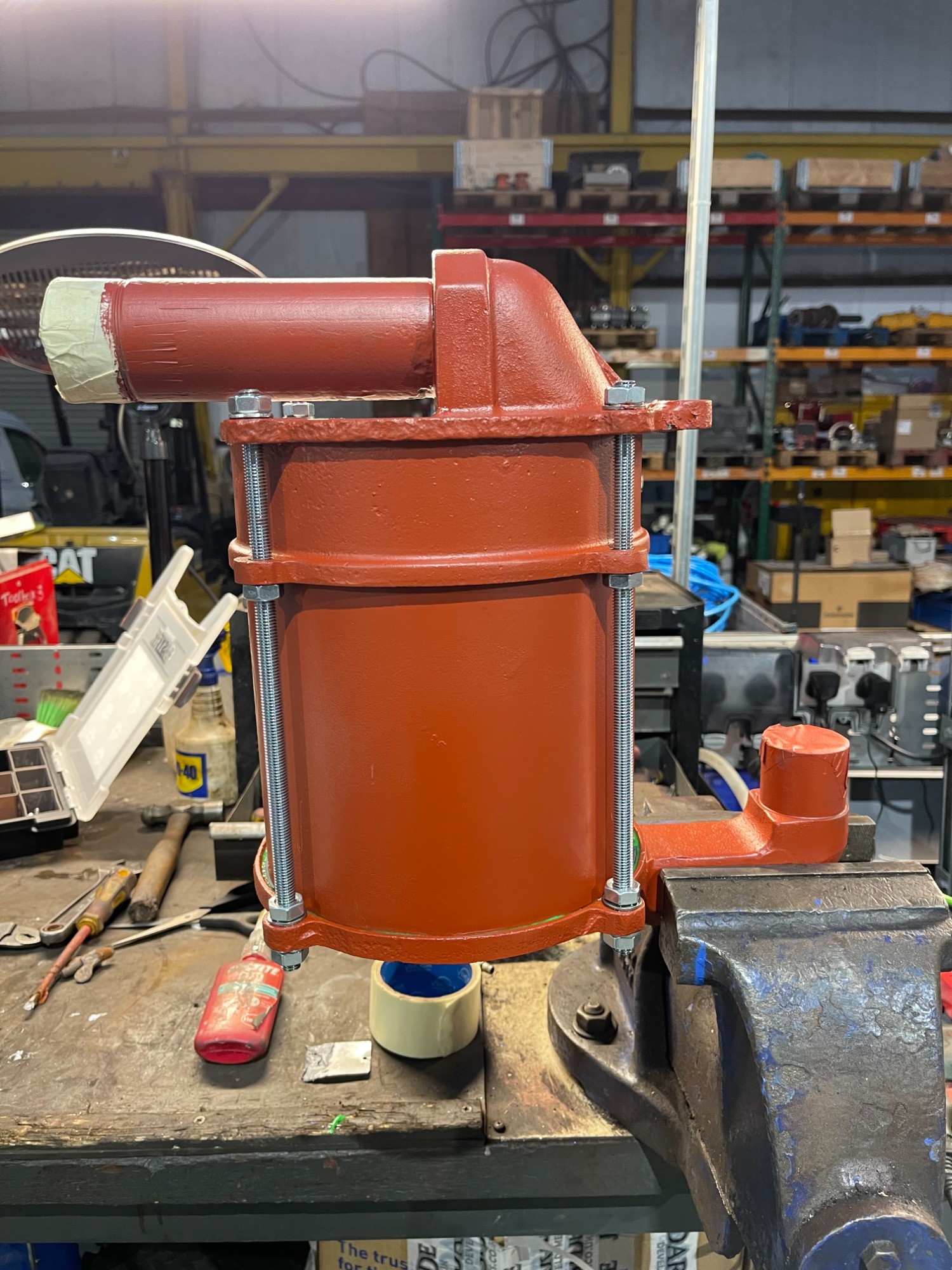

  • Work has also begun on the compressor housing, which was in poor condition and required attention ahead of the testing phase.
  • All brushes excluding the traction motor brushes have been inspected and thankfully show plenty of wear remaining before reaching their markers. In the coming weeks, we plan to position the locomotive over a pit to carry out further underside inspections.
  • The manual coolant fill pump has now been completely overhauled.
  • Finally, the gauges have been loosely fitted into the desk, allowing us to connect the air pipework in the near future for pressure testing. Once this stage is complete, attention can turn to assembling the desk properly.

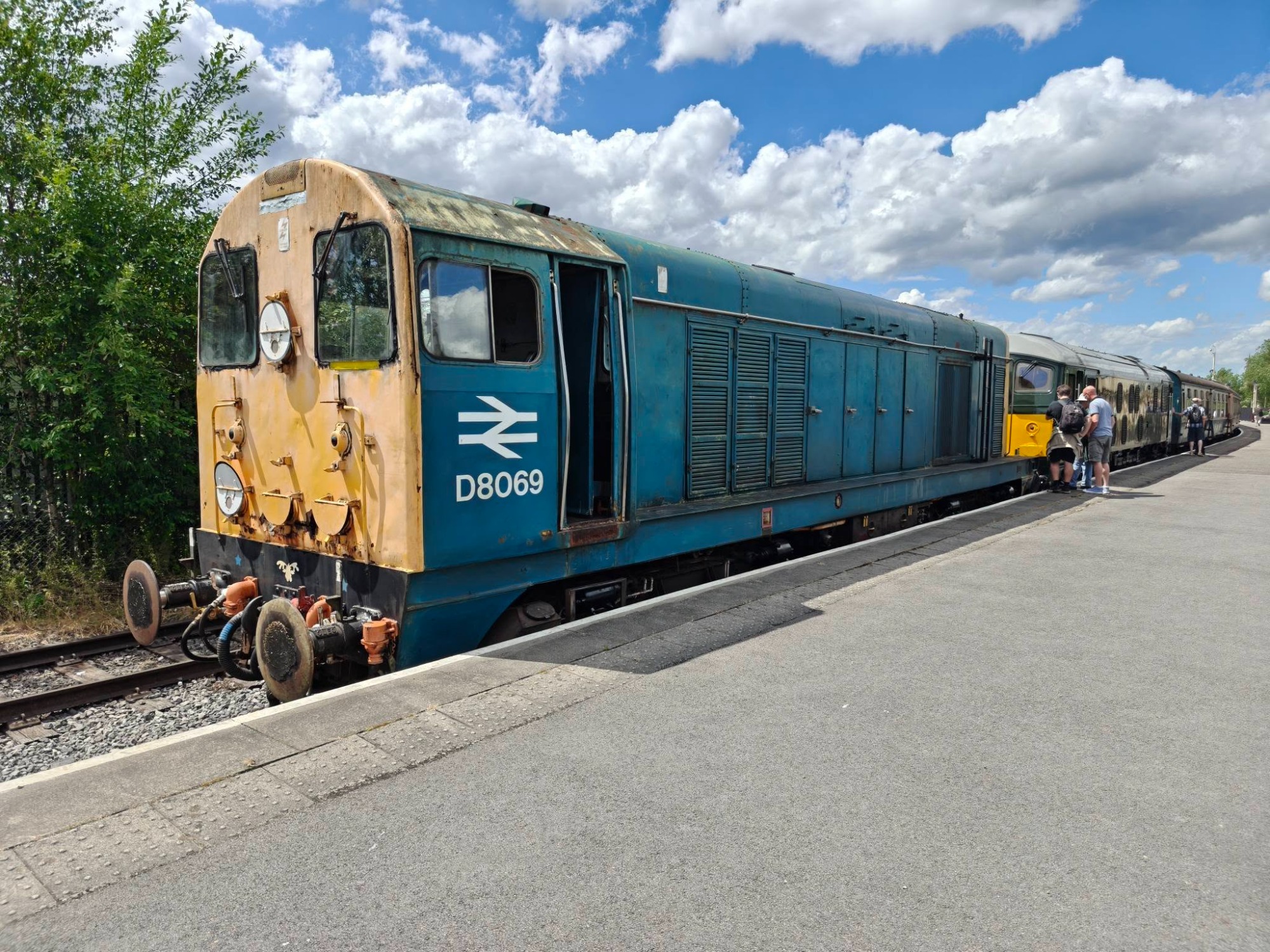

D8069's first start

After spending 6 days working through various parts of the locomotive to prepare for this day,
on the 22nd November 2025 we finally pressed the big green GO button and brought D8069 to life.
